Offshore Wind Developers Sue Trump: $25B Legal Showdown [2025]

Three offshore wind developers challenge the Trump administration's $25B project halt, citing national security concerns. Legal battle threatens clean energy...

offshore windTrump administrationenergy policyrenewable energylegal battle+10 more
Offshore Wind Developers Sue Trump: $25B Legal Showdown [2025]
Listen to Article
0:00
0:00
0:00

The $25 Billion Battle Over Offshore Wind Energy

Imagine investing billions into infrastructure projects that are 60 to 90 percent complete, only to have the government suddenly flip a switch and order everything to stop. That's exactly what happened in late December when the Department of the Interior issued a stop-work order affecting five major offshore wind projects along the Eastern Seaboard. The decision wiped out nearly $25 billion in planned investments and triggered an immediate legal firestorm.

This isn't just another regulatory dispute. It's a fundamental clash between energy ambitions, national security considerations, and the limits of executive power. Three major energy developers, Ørsted, Equinor, and Dominion Energy, have already filed lawsuits. Avangrid is reportedly considering legal action as well. What makes this situation unique is the sheer scale of the disruption, the financial stakes involved, and the murky justification behind the order.

The offshore wind industry has spent over a decade fighting for permits, conducting environmental reviews, and securing investment commitments. These projects represent some of the most advanced clean energy infrastructure in North America. Yet in a single administrative action, the pathway forward became uncertain. The legal challenges now underway will likely define the relationship between energy development and national security policy for years to come.

For energy companies, this represents an existential threat to the renewable energy transition. For policymakers, it raises hard questions about how security concerns should be weighed against energy independence and climate goals. For investors, it's a cautionary tale about the volatility of government policy in emerging energy sectors.

Let's break down what happened, why it matters, and where the legal battle is heading.

Understanding the Scope of the Halt

The December 22 stop-work order impacted five specific offshore wind projects, each at different stages of development and completion. This wasn't a vague directive—it affected real people, real money, and real timelines.

Revolution Wind represents the most advanced project among those halted. Developed jointly by Ørsted and Equinor as a 704-megawatt facility, the project was nearly 90 percent complete when the order came down. This project was designed to serve customers in Connecticut and New York, representing years of regulatory work and environmental assessment. The advanced completion stage makes the sudden halt particularly costly for developers, since much of the expensive infrastructure already existed.

Empire Wind, also developed by Equinor, is a 2-gigawatt facility off New York's coast. It was approximately 60 percent complete when construction stopped. This size alone makes it a critical piece of New York's renewable energy strategy. The project was expected to power around 2 million homes and represented a significant investment in East Coast energy infrastructure.

Coastal Virginia Offshore Wind, developed by Dominion Energy, is another 2.6-gigawatt project off Virginia's coastline. It was similarly 60 percent complete. Dominion subsequently disclosed that the halt was costing the company $5 million per day in losses. These aren't speculative figures, they're documented financial impacts based on operational costs, financing obligations, and contractual penalties.

Vineyard Wind 1, developed by Avangrid, is unique because it already has nearly 50 percent of the facility operational. This means some turbines are actively generating power and delivering electricity to the grid. The project is a 2.6-gigawatt facility with a different legal status than the others, which has complicated the response strategy.

South Fork Wind, a smaller 130-megawatt project, also fell under the halt order. Though smaller than the others, it still represents significant investment and disruption.

Combined, these projects would generate approximately 6 gigawatts of electricity once fully operational. To put that in perspective, 6 gigawatts is roughly equivalent to the power output of a large nuclear power plant. It's the difference between meeting significant portions of East Coast electricity demand through renewable sources versus relying on fossil fuels or imported power.

The halt also affects an estimated 1,200 workers currently employed on these projects. Union representatives immediately voiced concerns about job losses and the precedent set by stopping work on projects that were actively under construction. This workforce dimension adds another layer to the controversy.

Understanding the Scope of the Halt - visual representation
Understanding the Scope of the Halt - visual representation

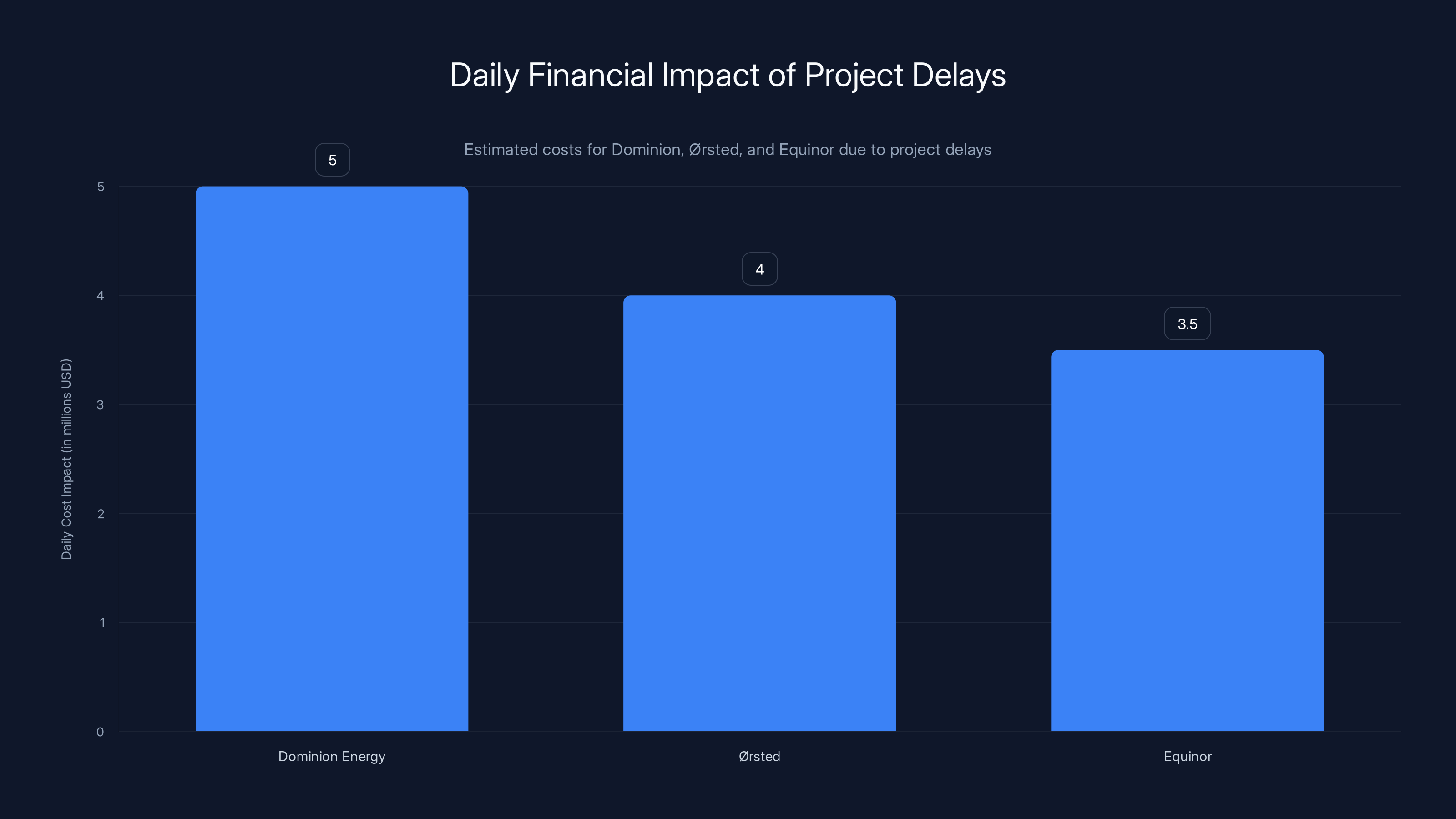

Daily Financial Impact of Project Delays
Daily Financial Impact of Project Delays

Dominion Energy faces the highest daily financial impact at

5millionduetoprojectdelays,followedbyØrstedandEquinorwithestimatedimpactsof5 million due to project delays, followed by Ørsted and Equinor with estimated impacts of
4 million and $3.5 million respectively. (Estimated data)

The National Security Justification: What Officials Actually Said

The Department of the Interior's official statement citing "national security concerns" was deliberately vague. No specific threats were identified, no evidence was presented, and no concrete scenarios were described. This ambiguity has become central to the legal challenges.

Industry observers and legal experts have pointed to one area of genuine concern: wind turbine radar interference. Modern wind turbines have rotating blades that can obscure or distort radar signals, particularly those used by the military for surveillance and navigation. This is a real, documented technical challenge that engineers have been working to address for over a decade.

In February 2024, the Department of Energy released a detailed report examining wind turbine interference with military radar systems. The report didn't recommend halting offshore wind projects. Instead, it outlined specific technical solutions and mitigation strategies that developers could implement. These included site selection optimization, radar system upgrades with adaptive processing algorithms, and operational coordination protocols.

The radar interference concern isn't new. Wind energy researchers and military officials have been collaborating on solutions since the early 2010s. Radar technology has evolved significantly since then. Modern radar systems use advanced signal processing algorithms that can filter out wind farm signatures with remarkable accuracy. The technology essentially teaches radar systems to distinguish between wind farm noise and actual threats.

What's peculiar about the stop-work order is that it doesn't mandate addressing the radar concern through any specific technical pathway. It simply halts operations. The developers of Vineyard Wind 1 had already agreed to fund radar adaptations and curtail operations when requested by the Pentagon. These collaborative agreements suggest that the security issue could be managed without stopping construction.

Military aviation officials do coordinate with the Bureau of Ocean Energy Management through the Military Aviation and Installation Assurance Siting Clearinghouse. This body reviews offshore wind projects individually and attempts to resolve any conflicts on a project-by-project basis. This formal process exists specifically to handle security concerns while allowing energy development to proceed.

The vagueness of the national security justification has fueled speculation about other possible motivations. Critics suggest the order may reflect political opposition to clean energy, concern about foreign-owned energy companies, or broader skepticism about renewable energy mandates. Without clearer reasoning, it's difficult to assess whether the security justification is proportionate or whether it's being used as cover for other policy objectives.

The National Security Justification: What Officials Actually Said - contextual illustration
The National Security Justification: What Officials Actually Said - contextual illustration

Completion Status of Halted Offshore Wind Projects
Completion Status of Halted Offshore Wind Projects

The stop-work order affected projects at various completion stages, with Revolution Wind being the most advanced at 90%. Estimated data for South Fork Wind.

The Legal Challenges: Three Lawsuits and Counting

Ørsted and Equinor filed their first lawsuit on January 2nd, challenging the stop-work order affecting Revolution Wind. Equinor filed a separate action addressing Empire Wind shortly after. Dominion Energy followed on January 3rd with its own legal challenge to the Coastal Virginia Offshore Wind halt. Each lawsuit argues that the order violates applicable law and causes unjustified harm.

The legal strategies differ slightly between developers, but they share common themes. The primary argument is that the Department of Interior exceeded its authority in issuing the stop-work order. The department does have authority over offshore energy development on federal lands and waters, but that authority isn't unlimited. Courts typically require that agency actions be grounded in clearly stated legal authority and that the action be proportionate to the problem being addressed.

Another key legal argument involves the Administrative Procedure Act, which requires that government agencies follow specific procedural steps before taking major actions. The sudden nature of the halt—with no advance notice, no opportunity for public comment, and no specific findings of fact—may violate these procedural requirements. If courts determine that the department failed to follow required procedures, they could nullify the order regardless of whether the underlying security concerns are legitimate.

The developers are also arguing that the halt causes irreparable economic harm and that there are no adequate legal remedies for the damage caused by stopping construction on projects that are mostly complete. This is the standard for obtaining a preliminary injunction that would allow work to resume while the case is litigated. Courts are more willing to grant such injunctions when the plaintiff can show genuine financial hardship.

A federal judge has already struck down an earlier Trump administration stop-work order affecting Revolution Wind. That November 2024 decision found that the original order lacked sufficient legal justification. The current halt is broader, but it operates on the same fragile legal foundation. The precedent of the earlier successful challenge gives developers confidence that courts will scrutinize this new order carefully.

Avangrid, which operates Vineyard Wind 1, hasn't filed suit yet. This may be a strategic choice. Vineyard Wind 1's unique status, with roughly half the facility already operational, creates different legal questions. The company may be pursuing settlement negotiations or exploring whether the halt actually applies to the portion of the facility already generating power.

The Legal Challenges: Three Lawsuits and Counting - visual representation
The Legal Challenges: Three Lawsuits and Counting - visual representation

The Financial Impact: Real Numbers, Real Consequences

Dominion Energy disclosed that the halt is costing the company $5 million per day. That figure includes ongoing financing costs, labor retention obligations, equipment leasing expenses, and contractual penalties to power purchasers who were expecting delivery of electricity from the completed facility.

Calculating the total financial impact across all five projects requires considering multiple cost categories. Construction costs don't simply pause and resume at the same rate. Extended schedules increase labor costs, financing costs accumulate on slower-than-expected project completion, and equipment degradation occurs when systems sit idle. Supply chain disruptions become more likely the longer construction is delayed.

For Dominion specifically, the company had contracted to deliver electricity to Virginia utilities beginning in the second half of 2025. Those contracts now can't be fulfilled. Utilities may penalize Dominion or seek alternative power sources. The uncertainty makes it difficult to retain or attract additional investment.

Ørsted and Equinor have significant debt obligations tied to project completion. Lenders typically require that projects reach operational milestones by specific dates. Extended delays trigger refinancing costs or default provisions. Both companies also have shareholder expectations about renewable energy expansion that this halt undermines.

Beyond the three companies with active lawsuits, the broader renewable energy supply chain is affected. Equipment manufacturers, installation contractors, and supporting service providers who were hired for these projects are now idled. Workers who left other jobs to take positions on these teams face uncertain employment.

The delayed clean energy capacity also has macroeconomic implications. The six gigawatts of capacity these projects would provide would reduce reliance on imported electricity from other regions and decrease demand for natural gas-fired power generation. The environmental cost of maintaining fossil fuel generation instead of deploying renewable capacity compounds over time.

In terms of investor confidence, the halt sends a chilling signal to energy companies considering major offshore wind investments. If projects that are 60 to 90 percent complete can be suddenly halted on murky security grounds, what's the point of investing billions in offshore wind development? This uncertainty could dampen future investment in renewable energy infrastructure across multiple sectors.

Financial Impact of Offshore Wind Halt
Financial Impact of Offshore Wind Halt

The halt of offshore wind projects affects approximately

25billioninprojectvalue,withDominionEnergylosing25 billion in project value, with Dominion Energy losing
5 million daily. Potential total economic damage could reach $50 billion if the halt persists. Estimated data.

Radar Interference: The Technical Problem Behind the Justification

Wind turbine radar interference is a genuine technical phenomenon with real military implications. Understanding the issue clarifies both why the government's security concern has merit and why it shouldn't necessarily halt projects that are nearly complete.

Radar systems work by emitting radio waves and detecting reflections from objects in the signal's path. Modern military radar is remarkably sophisticated, capable of detecting aircraft and missiles moving at high speeds and distinguishing them from background noise. However, large rotating objects like wind turbine blades can create confusing signals.

When radar energy strikes the rotating blades of a wind turbine, the reflection pattern changes constantly as the blades move. This creates a kind of clutter in the radar signal that makes it harder to identify genuine threats. In worst-case scenarios, wind farm clutter could mask an approaching aircraft or missile, creating a genuine security vulnerability.

The problem is most acute with older radar systems that lacked sophisticated signal processing algorithms. These systems struggled to filter out wind farm noise from legitimate targets. But radar technology has advanced dramatically since the early concerns about wind turbines were first raised.

Modern military radar systems use adaptive signal processing algorithms. These algorithms essentially teach the radar to recognize the signature of wind farm clutter and ignore it. They can filter out the known pattern of wind turbine blade reflections while remaining sensitive to the patterns created by aircraft or missiles. The technology is similar to active noise cancellation in headphones, except it's applied to radar signals.

Researchers have been working on these solutions for over a decade. Multiple government and private sector studies have documented the problem and the available solutions. The Department of Energy's February 2024 report reviewed this research and concluded that while the interference issue is real, it's manageable through technical solutions and site selection strategies.

The radar interference issue also varies significantly by location. Placing wind turbines far enough from critical radar installations reduces the interference problem. Siting wind farms in areas where military radar is less critical creates fewer conflicts. The military has established coordinating bodies precisely to address these location-specific concerns.

What's striking is that the stop-work order doesn't require developers to implement specific technical solutions. It doesn't mandate upgrades to radar systems, it doesn't require relocation of turbines, and it doesn't specify any particular remediation pathway. It simply says stop. This lack of specificity strengthens the legal case against the order, because it suggests the security justification may be pretextual.

Radar Interference: The Technical Problem Behind the Justification - visual representation
Radar Interference: The Technical Problem Behind the Justification - visual representation

A Brief History of Offshore Wind Policy in the United States

The offshore wind industry in the United States is remarkably young. Commercial-scale offshore wind development didn't begin until the 2020s, nearly two decades after Europe had already developed significant offshore capacity. Understanding this context helps explain why the current halt is so disruptive.

For years, offshore wind faced a combination of opposition from coastal constituencies concerned about viewshed impacts, political resistance from fossil fuel interests, and regulatory uncertainty. The Obama administration took early steps to streamline offshore wind permitting, but actual construction didn't materialize quickly.

The Biden administration made offshore wind a significant priority, establishing aggressive capacity expansion targets and directing the Department of Interior to fast-track permitting. The goal was to add 30 gigawatts of offshore wind capacity by 2030. This would make offshore wind a substantial portion of the nation's electricity generation portfolio.

Developers responded with billions in investment. Ørsted, Equinor, and other international energy companies saw the United States as a major growth opportunity. They began acquiring development rights, conducting environmental studies, and building the supply chains needed for large-scale offshore wind deployment.

The five projects now under halt represent the fruit of this investment and political commitment. They're not speculative ventures, they're commercial projects with real power purchase agreements and utility commitments. Banks lent billions based on the assumption that the permitting environment would remain stable.

Policy volatility is the offshore wind industry's greatest enemy. Unlike wind or solar on land, where local opposition is the primary constraint, offshore wind faces massive upfront capital costs. These projects only make economic sense if developers believe they'll be allowed to complete them and operate them for the 25 to 30-year lifespans necessary to recover their investments.

The current halt demonstrates exactly this kind of volatility. A regulatory environment can shift dramatically based on administrative decisions, potentially destroying the value of massive investments. This is precisely why the lawsuits are so important, and why developers are fighting hard to preserve their projects.

A Brief History of Offshore Wind Policy in the United States - visual representation
A Brief History of Offshore Wind Policy in the United States - visual representation

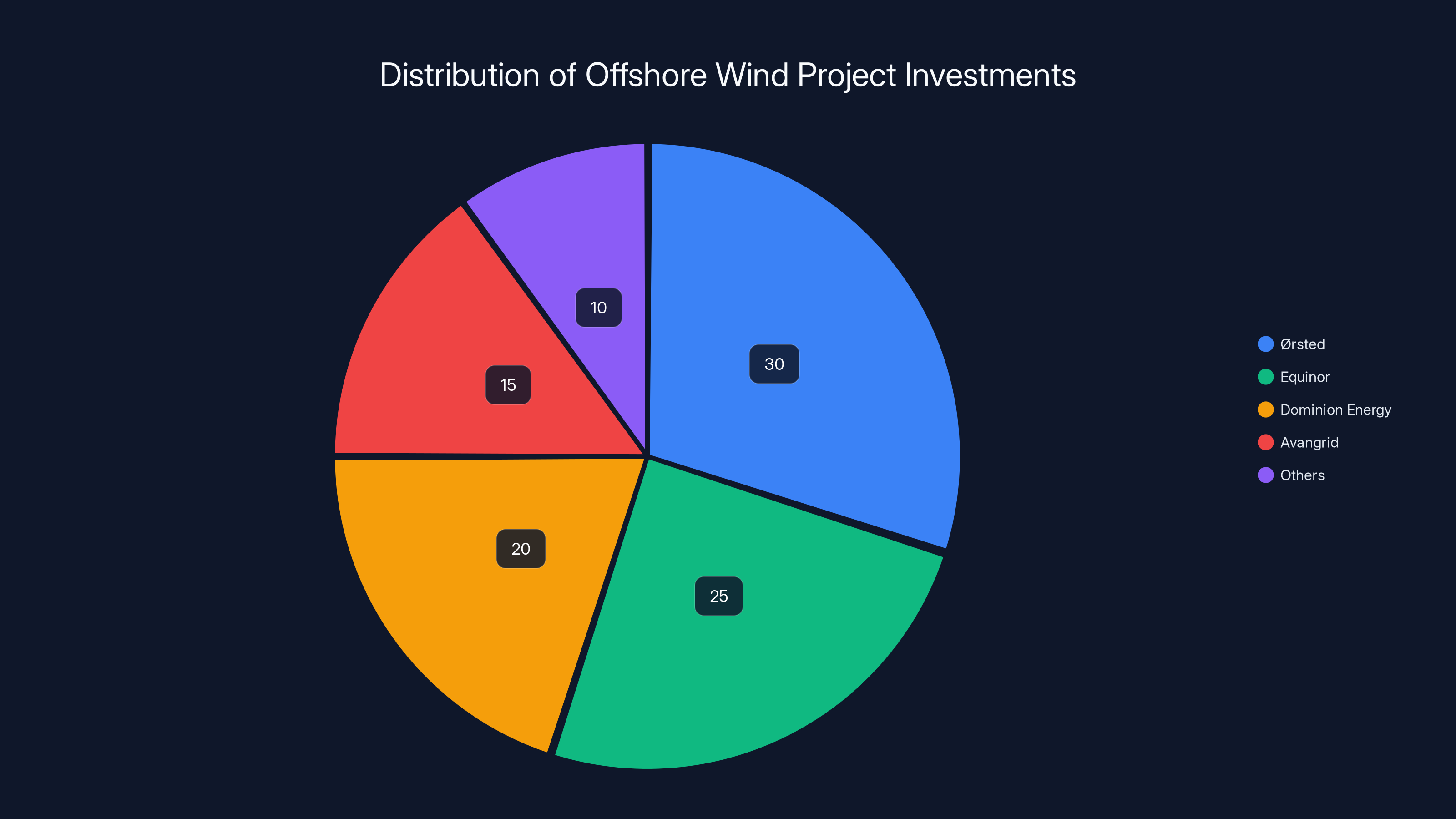

Distribution of Offshore Wind Project Investments
Distribution of Offshore Wind Project Investments

Estimated distribution of the $25 billion investment shows Ørsted and Equinor as major stakeholders. Estimated data.

The Military Coordination Framework: How It's Supposed to Work

The existing system for managing security concerns in offshore wind development isn't broken. It's just not being used. The Military Aviation and Installation Assurance Siting Clearinghouse exists specifically to review potential conflicts between military operations and energy development projects.

This interagency body brings together representatives from the Department of Defense, the Department of Interior, and energy developers. They review proposed offshore wind projects on an individual basis, assessing whether military radar systems, navigation systems, or other security infrastructure would be affected. If conflicts are identified, the group works to develop mitigation strategies.

These mitigation strategies have proven effective in practice. Vineyard Wind 1's developers agreed to fund radar modernization and to curtail operations when requested by the Pentagon. These collaborative agreements demonstrate that security concerns can be addressed without halting projects.

The formal coordination process also creates transparency. Developers know what standards they need to meet, they understand what modifications may be required, and they can plan accordingly. This clarity enables projects to move forward while ensuring that legitimate security concerns are addressed.

The sudden halt-without-coordination approach bypasses this established process. It provides no clear pathway for developers to address the security concerns. It offers no opportunity for the normal review process to work. This disconnect from established procedures is another reason courts may find the halt to be improper.

The existing framework isn't perfect, but it works better than administrative chaos. It balances security considerations against energy development objectives. It provides predictability for investors. And it preserves the ability for energy projects to move forward while ensuring military readiness.

The Military Coordination Framework: How It's Supposed to Work - visual representation
The Military Coordination Framework: How It's Supposed to Work - visual representation

International Competitors and the Geopolitical Dimension

This dispute takes place against a backdrop of international competition in offshore wind technology. European companies, particularly Ørsted and Equinor, have dominant market positions in offshore wind development globally. They brought their expertise and investment capital to the United States specifically because they saw opportunity.

The offshore wind market is genuinely competitive. Chinese manufacturers are producing turbines and components at scale. European companies are leading in offshore installation technology and project management. United States companies have lagged in developing domestic offshore wind supply chains, instead importing components and expertise from abroad.

This international dimension creates a layer of complexity to the halt. If the Trump administration is concerned about foreign control of critical energy infrastructure, that's a different concern than radar interference. But it's never been articulated as the official justification.

The geopolitical stakes are real. Renewable energy infrastructure is increasingly recognized as strategically important. Countries that lead in clean energy technology and manufacturing will have significant economic and political advantages in the coming decades. The United States has fallen behind Europe and China in offshore wind capacity, partly due to domestic opposition and regulatory uncertainty.

The current halt risks widening this competitive gap. While the United States delays, Europe and China continue building offshore wind capacity at scale. By the time United States permitting becomes stable again, foreign companies will have further consolidated their technological and market advantages.

For multinational companies like Ørsted and Equinor, the calculus is straightforward. If the United States is an unstable market where projects can be halted without clear legal justification, they'll redirect investment capital to more stable jurisdictions. This could actually harm the United States renewable energy transition, not protect it.

International Competitors and the Geopolitical Dimension - visual representation
International Competitors and the Geopolitical Dimension - visual representation

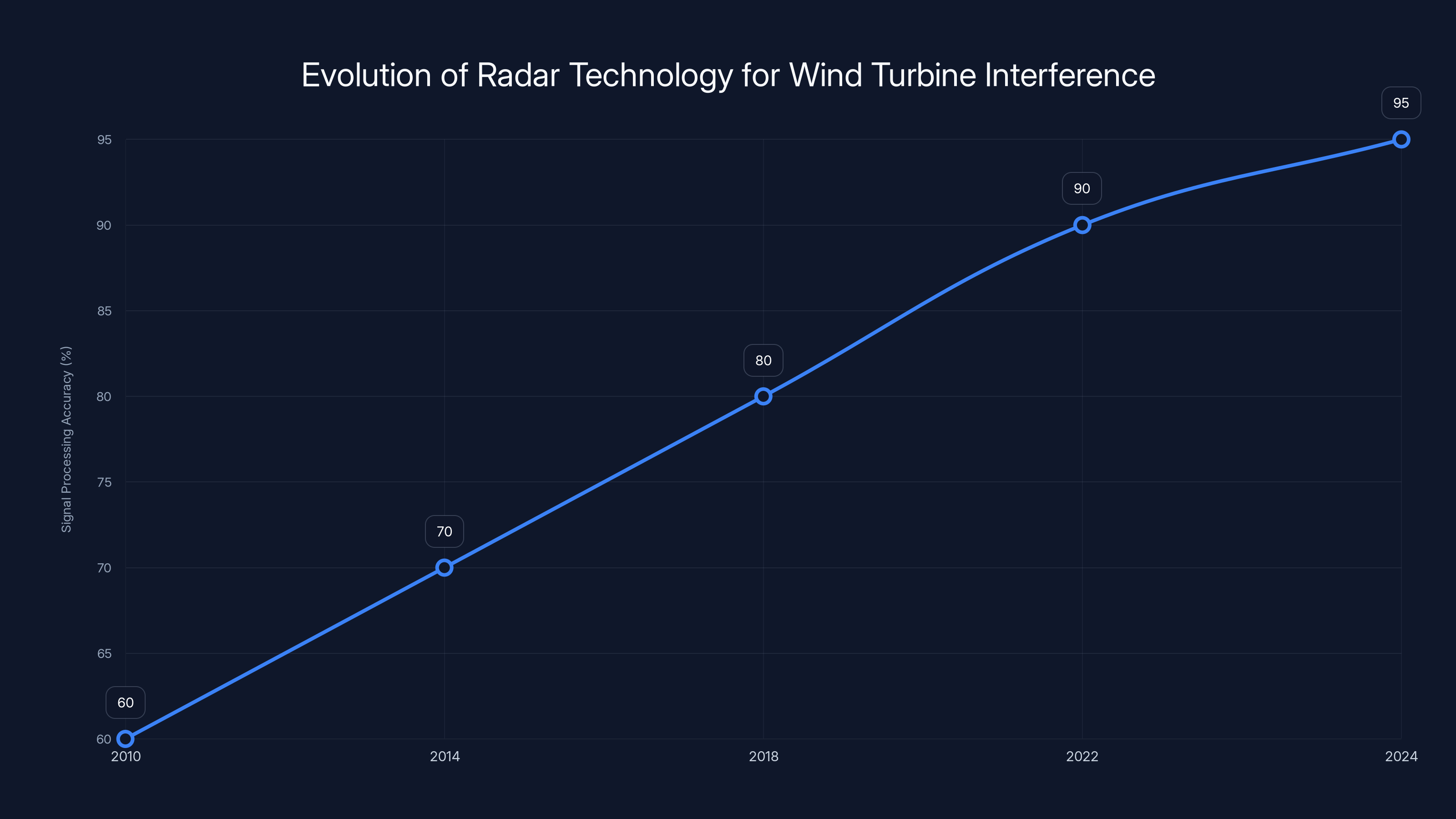

Evolution of Radar Technology for Wind Turbine Interference
Evolution of Radar Technology for Wind Turbine Interference

Estimated data showing the significant improvement in radar signal processing accuracy over time, which helps mitigate wind turbine interference with military radar systems.

Employment and Labor Implications

The halt affects roughly 1,200 workers currently employed on these projects. These aren't low-wage jobs. Offshore wind installation work pays between

50and50 and
80 per hour, with benefits. Union representatives from the International Brotherhood of Electrical Workers immediately protested the halt, emphasizing the impact on their members.

Construction workers, electricians, engineers, and logistics personnel were hired specifically for these projects. Some relocated to be closer to work sites. Others left previous jobs to take these positions. The sudden halt creates immediate uncertainty about continued employment and income.

Union contracts typically provide some protections and benefits, but they don't fully compensate for the loss of steady work. Workers may be idle for months while the legal challenges are resolved. Some may seek other employment, creating a talent drain from the industry. Others may remain on standby status, collecting partial benefits while waiting for work to resume.

The long-term implications are more significant. If offshore wind development becomes unreliable, skilled workers won't invest in training for offshore wind careers. Technical schools and union apprenticeship programs will be reluctant to create offshore wind curricula if the industry can't guarantee stable work. The human capital needed to support a growing offshore wind industry will fail to develop.

This creates a self-fulfilling prophecy. Without stable policy, workers won't develop specialized skills. Without skilled workers, companies can't execute projects efficiently. Without efficient execution, costs remain high. High costs make projects less competitive. Uncompetitive projects don't attract investment. This cycle explains why policy stability matters so much in emerging energy sectors.

Employment and Labor Implications - visual representation
Employment and Labor Implications - visual representation

The Precedent of Earlier Trump Administration Actions

The current halt isn't the first time the Trump administration has challenged offshore wind projects. In November 2024, the administration issued a stop-work order affecting Revolution Wind. A federal judge struck down that order, finding insufficient legal justification.

That earlier decision provides important context for the current lawsuits. The judge's reasoning established that executive action must be grounded in clearly stated legal authority and that the justification must be specific enough to withstand judicial scrutiny. A vague invocation of national security concerns isn't sufficient.

The current December halt is broader than the November order, but it operates under the same legal vulnerability. If a court found the narrow November order improper, a broader order with even vaguer justification faces similar problems.

The Trump administration also halted approvals for new offshore wind projects earlier in 2024. The stated rationale was to allow time for review and assessment. However, reviews of existing projects that are already under construction are more legally problematic than halting approvals for future projects. Courts are more skeptical of actions that disrupt ongoing operations than actions that delay future approvals.

This sequence of actions suggests a pattern of administrative hostility toward offshore wind. But pattern isn't the same as clear legal justification. Courts will evaluate whether each action is independently defensible, not whether it's consistent with an overall policy direction.

The Precedent of Earlier Trump Administration Actions - visual representation
The Precedent of Earlier Trump Administration Actions - visual representation

U.S. Offshore Wind Capacity Targets and Progress
U.S. Offshore Wind Capacity Targets and Progress

The U.S. aims to reach 30 GW of offshore wind capacity by 2030, reflecting a significant policy shift and investment in renewable energy. (Estimated data)

Litigation Timeline and Likely Outcomes

The lawsuits filed by Ørsted, Equinor, and Dominion follow a standard federal court process. The first stage typically involves a motion for a preliminary injunction, which is a request to halt the government's stop-work order while the case is litigated. This is crucial because the longer construction remains halted, the greater the economic damage and the more likely that projects become uneconomical.

For a preliminary injunction, developers must demonstrate four factors. First, they must show a substantial likelihood that they'll ultimately prevail on the merits of their legal claims. Second, they must show that without an injunction, they'll suffer irreparable harm that money damages can't fully compensate. Third, they must show that the balance of equities favors their position. Fourth, they must show that an injunction is in the public interest.

The first factor is strong for developers. The earlier court decision striking down the November halt order suggests that the legal arguments challenging the December halt have merit. Courts have consistently held that executive actions must be grounded in specific legal authority, not vague invocations of national security.

The second factor is also strong. Projects that are 60 to 90 percent complete face massive economic harm from extended halts. Construction workers become unavailable, equipment degrades, financing costs accumulate, and supply chain commitments are broken. These harms are genuinely irreparable in the sense that money damages alone can't restore the projects to their previous trajectory.

The third factor, balance of equities, depends on whether the court finds the national security justification credible. If the court is skeptical about the security justification, the balance clearly favors the developers. If the court deems the security concerns legitimate, the balance is more complex.

The fourth factor, public interest, also likely favors developers. The public has an interest in clean energy supply, employment in the energy sector, and predictable regulatory policy. These interests support allowing construction to continue on projects that have already been vetted through the formal permitting process.

If courts grant preliminary injunctions, construction can resume while the legal case proceeds. The actual merits of the dispute might not be resolved for years, but that's far less damaging than indefinite construction halts.

The substantive legal claims likely to succeed involve the Administrative Procedure Act. This statute requires that agencies follow specific procedures before taking major actions and that agency decisions be supported by adequate explanation. A sudden halt without notice or opportunity for comment may violate these requirements. A halt justified by vague national security concerns unsupported by specific findings or evidence may fail the reasoned explanation requirement.

Another legal strategy involves challenging whether the Department of Interior has statutory authority to halt projects that are already under construction. The department's permitting authority is clear, but whether it can shut down ongoing construction is a different question. Statutes sometimes contain provisions limiting the department's power to interfere with private operations once certain conditions have been met.

The Executive Power Clause of the Constitution provides another potential argument. If the department's action effectively seizes private property or destroys private economic interests without clear statutory authority, it might violate Fifth Amendment takings principles. This is a more aggressive legal argument, but it could be relevant given the massive economic harm involved.

Litigation Timeline and Likely Outcomes - visual representation
Litigation Timeline and Likely Outcomes - visual representation

Potential Settlements and Political Resolutions

Lawsuits are expensive, time-consuming, and uncertain. Both sides have incentives to settle. The Trump administration could modify the halt order to allow certain projects to proceed under enhanced security protocols. Developers could agree to radar system upgrades or operational restrictions to address security concerns.

A settlement could include requirements that developers upgrade military radar systems in nearby areas, fund research on improved radar filtering algorithms, or commit to curtailing operations when military exercises or deployments are occurring. These are real security measures that don't require halting construction on projects that are already nearly complete.

Another settlement pathway involves allowing the portion of Vineyard Wind 1 that's already operational to continue operating while the remainder of the project remains under halt pending further review. This creates a middle ground where some benefits of the projects accrue while the government conducts additional analysis.

The political dimension matters too. If public opposition to offshore wind grows, the Trump administration might find political benefits in maintaining the halt. Conversely, if coastal communities and utilities demonstrate strong support for the projects, the political calculus changes. Business groups and labor unions have already expressed strong opposition to the halt.

The degree to which Congress becomes involved also affects resolution pathways. If Congress passes legislation clarifying that the Department of Interior doesn't have authority to halt projects under construction, that would resolve the dispute legislatively. Several members of Congress from affected states have already indicated skepticism about the halt.

Potential Settlements and Political Resolutions - visual representation
Potential Settlements and Political Resolutions - visual representation

Energy Markets and the Broader Clean Energy Transition

The halt creates ripple effects throughout the electricity markets of the Northeast. Power generators, utilities, and grid operators were planning based on the assumption that these gigawatts of capacity would come online. Now they must adjust plans.

Utilities in New York, Connecticut, and Virginia had contractually committed to purchasing electricity from these projects. The halt means they won't receive the contracted power. They'll either need to source power from alternative sources or face penalties for non-compliance. This increases energy costs for consumers in these regions.

Natural gas-fired power plants that were expected to be displaced by offshore wind now face continued high utilization. This extends the operational life of fossil fuel infrastructure and increases carbon emissions. The climate impact of delaying 6 gigawatts of clean energy capacity is substantial when measured over years.

The offshore wind supply chain also faces disruption. Equipment manufacturers that built turbines and components for these projects must find alternative markets. Installation vessels and specialized equipment that were chartered for construction now sit idle or must be redeployed. The cost of idling capital equipment is substantial.

Regional electricity prices are affected too. In competitive electricity markets, prices are set by the most expensive generator needed to meet demand. With clean energy capacity delayed, more expensive fossil fuel generation sets prices. Consumers pay higher electricity bills. This indirectly harms the competitiveness of clean energy industries that consume significant electricity.

Energy Markets and the Broader Clean Energy Transition - visual representation
Energy Markets and the Broader Clean Energy Transition - visual representation

International Perspectives and Global Precedent

The halt is noteworthy from an international perspective. Most developed nations are aggressively expanding offshore wind capacity. Europe has built significant offshore wind infrastructure. China is developing massive offshore wind resources. Even some developing nations are beginning offshore wind projects.

The United States action stands out as countertrend. Most developed nations view offshore wind as essential for meeting climate goals and achieving energy independence from fossil fuels. The Trump administration's skepticism is unusual in the global context.

There are also international legal implications. The United States has trade agreements with the nations where companies like Ørsted and Equinor are based. European governments may view the halt as discriminatory treatment of foreign-owned energy companies. They might invoke trade dispute mechanisms or retaliation mechanisms if they believe American companies are being favored.

The precedent matters too. If the United States can halt foreign-owned energy infrastructure projects on vague security grounds, other nations may feel entitled to do the same. This could trigger a wave of protectionist energy policies that undermine global energy markets and slow the clean energy transition worldwide.

International Perspectives and Global Precedent - visual representation
International Perspectives and Global Precedent - visual representation

Key Takeaways and What Happens Next

The offshore wind lawsuit represents a critical juncture for clean energy development in the United States. Multiple dimensions converge: legal authority, security concerns, economic impacts, employment effects, and international competition.

The legal dimensions favor developers. The earlier court decision striking down a similar halt order provides precedent. The procedural irregularities in the December halt—absence of notice, lack of opportunity for comment, vague justification—create legal vulnerabilities. Courts may well grant preliminary injunctions allowing construction to resume while litigation continues.

But legal victory doesn't guarantee ultimate success. Even if courts rule against the halt order, the Trump administration could pursue other mechanisms to obstruct offshore wind development. It could refuse to grant permits for new projects, it could impose new environmental review requirements, or it could attempt legislative changes to its authority.

The business dimension is equally important. Developers are losing millions per day. They have strong financial incentives to settle or negotiate. But if the administration refuses to budge, developers must be willing to litigate indefinitely while construction remains halted. Some projects might become uneconomical if the halt extends long enough.

The political dimension may ultimately determine outcomes. If public support for offshore wind remains strong in affected states, political pressure will mount on the Trump administration to back down. Conversely, if fossil fuel interests successfully frame offshore wind as a threat, the administration may double down on obstruction.

What's clear is that the next few months will be crucial. Preliminary injunction decisions will signal how sympathetic courts are to developer arguments. Settlement negotiations will reveal whether accommodation is possible. Congressional responses will indicate whether Congress views the halt as appropriate or overreaching.

The offshore wind industry is too important to be left unresolved. Six gigawatts of capacity is equivalent to serving millions of homes with clean electricity. The employment and supply chain implications are substantial. The international precedent matters for global energy markets. This dispute will likely occupy significant attention from courts, regulators, and policymakers throughout 2025.

Key Takeaways and What Happens Next - visual representation
Key Takeaways and What Happens Next - visual representation

FAQ

What is the offshore wind halt about?

In December 2024, the Department of Interior issued a stop-work order affecting five offshore wind projects worth approximately $25 billion along the Eastern Seaboard. The order cited national security concerns, specifically relating to wind turbine interference with military radar systems. Projects that were 60 to 90 percent complete were suddenly halted, triggering multiple lawsuits from developers seeking to reverse the decision.

Why did the Trump administration halt the projects?

The official justification involves national security concerns about wind turbine interference with military radar systems. Wind turbines' rotating blades can create interference patterns in radar signals, potentially obscuring aircraft or missiles. However, the Department of Interior provided no specific details about the threat, no technical analysis supporting the halt, and no timeline for when construction might resume. This vagueness has fueled skepticism about whether security is the true justification.

How much money is at stake?

Approximately

25billionintotalprojectvalueisaffectedbythehalt.DominionEnergyalonedisclosedthatthecompanyislosing25 billion in total project value is affected by the halt. Dominion Energy alone disclosed that the company is losing
5 million per day. Additional losses include financing costs, labor expenses, equipment depreciation, and penalties to utilities and power purchasers who were expecting electricity from the completed facilities. The total economic damage could exceed $50 billion if the halt extends for several years.

What are the legal arguments against the halt?

Developers argue that the Department of Interior exceeded its statutory authority in halting construction on projects already permitted and under construction. They also argue that the administration violated the Administrative Procedure Act by taking major action without notice, opportunity for public comment, or adequate explanation. A federal judge previously struck down a narrower version of the halt order in November 2024, creating precedent for the current legal challenges.

What are the chances that courts will overturn the halt?

Developer chances of success appear relatively strong based on the earlier court decision and established legal principles. Courts have consistently held that executive actions must be grounded in clearly stated legal authority and reasonable explanation. The vague national security justification, combined with procedural irregularities, creates legal vulnerabilities. However, courts typically give deference to security decisions, so the outcome isn't certain.

How does wind turbine radar interference actually work?

Wind turbines' rotating blades create changing radar reflections that can appear as clutter in military radar systems. Older radar systems struggled to distinguish this clutter from genuine threats like aircraft or missiles. Modern radar systems use advanced signal processing algorithms that can filter out wind farm signatures while remaining sensitive to actual threats. Technical solutions for managing this interference have been available and proven effective for several years.

What happens if developers win the lawsuits?

If courts grant preliminary injunctions, construction can resume while the legal case proceeds. Developers could begin moving equipment, rehiring workers, and completing installations. The underlying merits of the dispute might be litigated for years, but work wouldn't need to remain halted pending final resolution. A favorable court decision could also prevent future halts without proper legal justification.

Could the administration impose new restrictions instead of outright halts?

Yes. Even if courts overturn the complete halt, the administration could impose operational restrictions, require radar system upgrades, mandate curtailment during military exercises, or impose other conditions. These would be more defensible legally if properly justified and implemented through normal administrative procedures. Some developers might accept modified projects if completion is allowed rather than facing indefinite halts.

Why does offshore wind matter for energy independence?

Offshore wind can generate electricity at significant scale with minimal land use conflicts. Six gigawatts of capacity would power millions of homes, reducing reliance on fossil fuels and imported electricity. Offshore wind is particularly valuable for coastal regions where land-based wind development faces opposition. The technology is proven and scaling rapidly globally. Delaying these projects weakens energy independence and extends reliance on natural gas and coal.

What are the employment impacts of the halt?

Approximately 1,200 workers employed on these projects face uncertain employment and income. Specialized offshore wind installation work pays

50to50 to
80 per hour with benefits. Extended halts could cause workers to seek employment elsewhere, draining expertise from the industry. Long-term supply chains for equipment, vessels, and services are also disrupted, affecting hundreds of additional workers in supporting industries.

How does this affect the broader clean energy transition?

The halt sends a chilling signal to companies considering renewable energy investments. If projects can be halted on vague grounds after billions in investment, the risk-reward calculation changes. International companies may redirect investment capital to more stable jurisdictions. Domestic companies may reduce clean energy ambitions. The overall effect is to slow the United States clean energy transition and cede leadership to international competitors already scaling offshore wind at pace.

What role does Congress play?

Congress could clarify that the Department of Interior lacks authority to halt projects already under construction. Representatives from affected states have expressed skepticism about the halt. Congressional action could resolve the dispute legislatively rather than waiting for years of litigation. However, Congress must overcome partisan divisions on energy policy, which may prevent action despite the bipartisan importance of energy stability.

FAQ - visual representation
FAQ - visual representation

Related Articles

Cut Costs with Runable

Cost savings are based on average monthly price per user for each app.

Which apps do you use?

Apps to replace

ChatGPTChatGPT
$20 / month
LovableLovable
$25 / month
Gamma AIGamma AI
$25 / month
HiggsFieldHiggsField
$49 / month
Leonardo AILeonardo AI
$12 / month
TOTAL$131 / month

Runable price = $9 / month

Saves $122 / month

Runable can save upto $1464 per year compared to the non-enterprise price of your apps.
