Openreach Copper Network Price Hikes Force Business Migration [2025]

Openreach is raising copper network prices 100% in 2025 to force business users to fiber. Understand the timeline, costs, and migration strategy required.

openreachcopper network shutdownPSTN migrationbusiness telecommunicationsfiber optic+10 more
Openreach Copper Network Price Hikes Force Business Migration [2025]
Listen to Article
0:00
0:00
0:00

The Copper Network Crisis: Why Openreach Is Forcing a Mass Business Migration

It's happening right now, and honestly, most businesses don't realize it yet. Openreach, the UK's dominant telecommunications infrastructure operator, is executing a coordinated price squeeze on legacy copper networks that will effectively double what businesses pay by October 2025. This isn't a gradual market shift. It's a deliberate, aggressive push to eliminate an aging technology that's been the backbone of British communications for decades. According to ITPro, this move is designed to accelerate the transition to modern infrastructure.

Here's the situation: around 500,000 business lines are still using the old PSTN (Public Switched Telephone Network)—copper wires that were installed when rotary phones were cutting-edge technology. The UK government and Openreach have committed to shutting this network down completely by January 31, 2027. That's just over a year away. To accelerate the migration before that deadline hits, Openreach has announced three significant price hikes scheduled for April, July, and October 2025. The first wave is 20%, but the subsequent ones are brutal: 40% each time. By the time October rolls around, copper lines will cost roughly double what they did at the start of the year, as detailed by ISPreview.

Why does this matter? Because if you're running a business with legacy phone systems, outdated PBX equipment, or fax machines still connected to copper lines, you're about to face a painful choice: migrate to fiber or watch your telecommunications costs skyrocket while your infrastructure becomes unsupported. And this is only the beginning. The pressure will intensify as the 2027 deadline approaches, as noted by The Register.

What makes this situation particularly interesting is that the technical barriers to migration have been completely eliminated. Openreach has spent years removing every legitimate excuse. Telecare systems (medical alert devices) have been sorted through their 'Prove Telecare' initiative. Fax machines can work over fiber. Even ancient ISDN lines have workarounds. The infrastructure exists. The capability exists. The only thing left is the financial incentive, and Openreach is manufacturing that through pricing.

This article breaks down everything businesses need to know: why this transition is happening, what it costs, how to prepare for it, and what alternatives exist. If you haven't already started your migration planning, the clock is ticking much louder than you think.

TL; DR

  • Copper price hikes: 20% in April, 40% in July, 40% in October 2025 means roughly double the cost by year-end
  • Deadline pressure: UK copper network shuts down January 31, 2027 with 500,000 business lines still unmigrated
  • Technical barriers removed: Telecare protections, fax compatibility, and equipment workarounds are now solved
  • Migration urgency: Providers who haven't contacted customers are failing their obligations; businesses should switch providers if not contacted
  • Cost comparison: Fiber connections offer better performance, reliability, and long-term economics despite initial migration costs

TL; DR - visual representation
TL; DR - visual representation

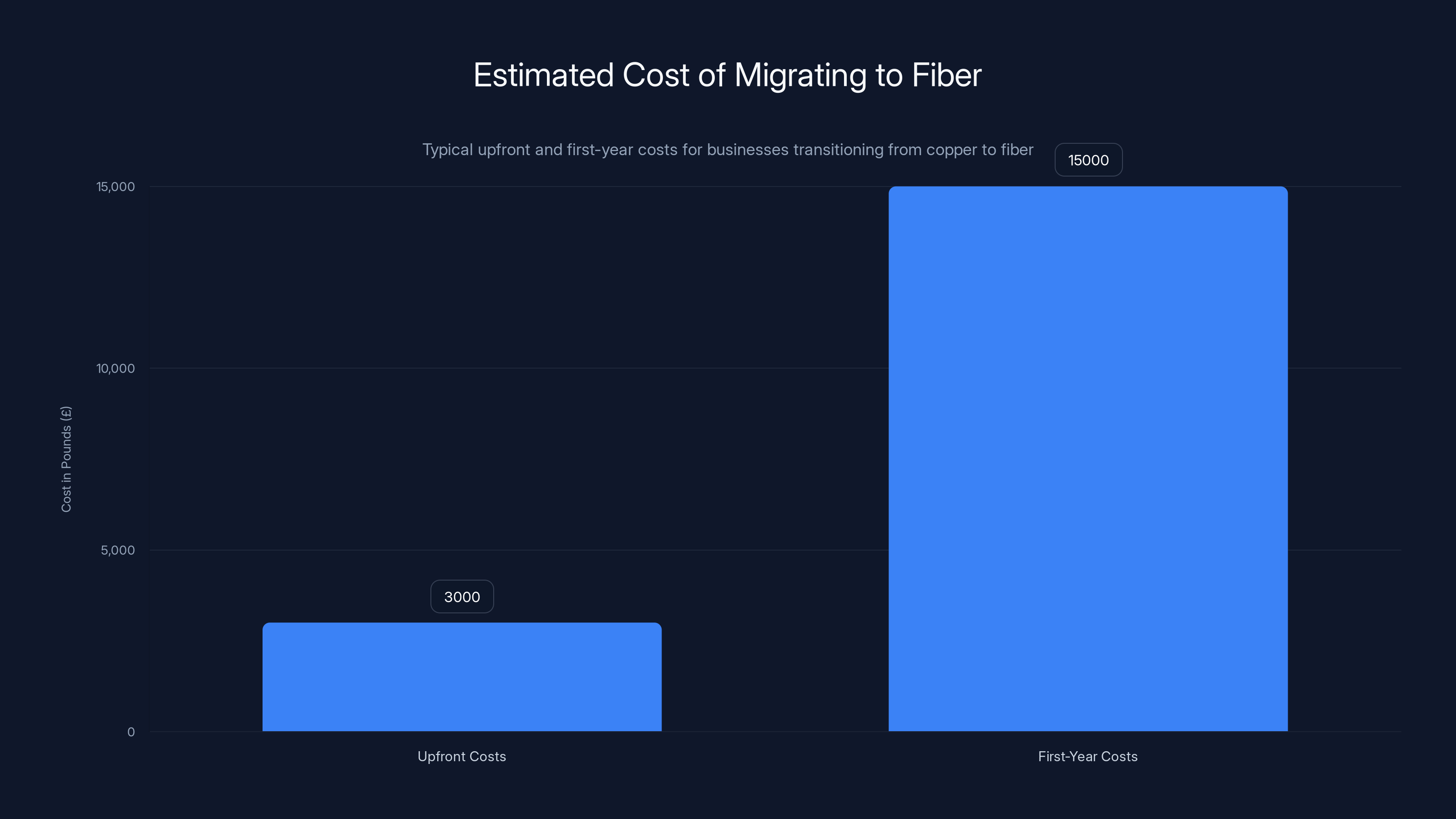

Estimated Cost of Migrating to Fiber
Estimated Cost of Migrating to Fiber

Estimated data shows that upfront costs for migrating to fiber range from £3,000 to £15,000, with first-year costs typically 10-30% higher than current copper costs. Estimated data.

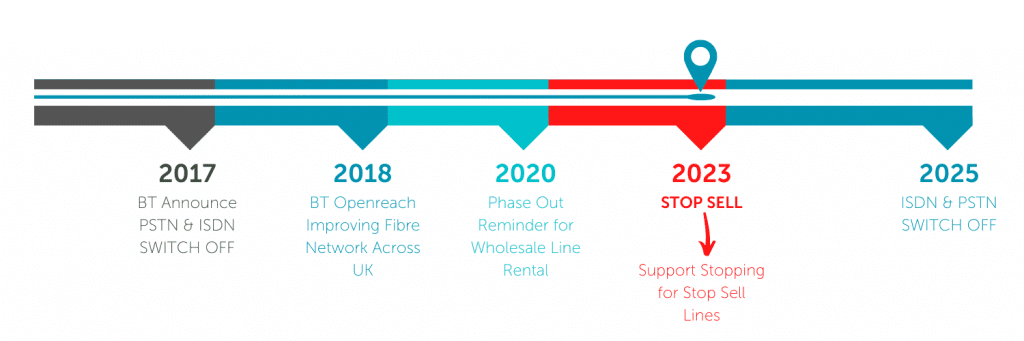

Understanding the PSTN Shutdown and Why It's Happening

The Public Switched Telephone Network was revolutionary when it launched. It connected the entire nation through analog copper wires, and for nearly a century, it worked. Businesses relied on it. Hospitals used it for emergency systems. Elderly people depended on it for medical alerts. It was ubiquitous, reliable, and honestly, it's been an engineering marvel.

But copper networks are aging infrastructure. They require constant maintenance. They're vulnerable to weather damage. They're expensive to support as manufacturing of components diminishes and engineers retire. More importantly, they're being replaced by superior alternatives. Fiber optic networks provide infinitely more capacity, faster speeds, better reliability, and lower operational costs at scale, as highlighted by NCTA.

The decision to shut down PSTN came from both Openreach (commercially motivated) and the UK government (policy driven). The government wants to modernize critical infrastructure and align with other developed nations, many of whom have already completed this transition. Openreach wants to reduce the cost burden of maintaining legacy systems and redirect those resources toward fiber deployment. This is essentially infrastructure evolution—painful, but necessary, as explained by Light Reading.

The key thing to understand is that this wasn't a surprise announcement. The shutdown timeline was published years ago. Openreach has been communicating this for a long time. But adoption has been slow. People procrastinate. Businesses assume they have more time than they actually do. Then suddenly, the deadline is 18 months away and you haven't done anything yet.

What's different now is that Openreach has decided passive communication isn't enough. Businesses need an active incentive to move. That incentive is price. When your annual phone bill triples, suddenly the migration project becomes a board-level priority instead of something IT manages whenever they get around to it.

The analogy is useful: imagine you're driving a car from the 1990s. The manufacturer stops making parts, the repair shops close down, the fuel becomes increasingly hard to find. Eventually, you don't have a choice anymore—you need a new car. Openreach is essentially accelerating the timeline by making the old car prohibitively expensive to maintain.

Understanding the PSTN Shutdown and Why It's Happening - visual representation
Understanding the PSTN Shutdown and Why It's Happening - visual representation

Comparison of Fiber vs. Copper Connectivity
Comparison of Fiber vs. Copper Connectivity

Fiber optic connectivity significantly outperforms copper across all key metrics, offering higher speed, lower latency, better reliability, scalability, a more favorable cost trajectory, and enhanced security. Estimated data for comparison.

The Specific Price Hike Timeline and What It Means

Let's get concrete about the numbers, because this is where it gets urgent.

Openreach has scheduled three price increases throughout 2025:

April 2025: 20% price increase on all legacy copper business lines. If you're paying £100/month currently, you'll pay £120. Not catastrophic, but noticeable.

July 2025: 40% price increase on top of April's new price. Your £120 bill jumps to £168. Now you're 68% above where you started the year.

October 2025: Another 40% increase. Your £168 bill becomes £235. That's 135% of the original price. Roughly double.

By the end of 2025, a business line that cost £100/month will cost somewhere between £220-240/month, depending on how Openreach structures the cumulative calculation. Over a year, that's an additional £1,440-1,680 per line in extra costs. For a business with 10 lines, you're looking at £14,400-16,800 in extra annual spending. For 50 lines, it's £72,000-84,000 in new expenses.

What makes this particularly aggressive is the compressed timeline. Most pricing strategies phase increases over years. Openreach is doing it in six months. This is intentional—they want to create immediate pain that forces action.

QUICK TIP: Start your migration assessment NOW, not in April. Migration projects take 3-6 months to properly plan and execute. If you wait for the price hikes to hit, you'll be making desperate decisions under pressure.

The financial impact compounds when you realize that fiber connections often cost the same or less than these inflated copper prices. You could be paying 60-70% more for slower, less reliable service while a modern alternative costs the same or less. The economics flip entirely once you price in the multiple increases.

For some businesses, particularly those with dozens of lines, the math becomes forceful: migrate now and absorb transition costs, or pay double for the privilege of delaying. Openreach has effectively set a deadline that has real financial teeth.

The Specific Price Hike Timeline and What It Means - visual representation
The Specific Price Hike Timeline and What It Means - visual representation

Why the Copper Network Shutdown Was Always Coming

This isn't a sudden decision or a corporate whim. The shutdown of PSTN networks is happening across developed economies. Germany, France, the Netherlands, and Denmark have already completed their transitions. The US is in the process. Canada is planning theirs. This is a global trend, not a UK-specific anomaly.

The reasons are both technical and economic. From a technical standpoint, copper networks were designed for voice-only communication. They have bandwidth limitations that fiber doesn't have. They're susceptible to interference, weather damage, and electromagnetic issues that fiber avoids entirely. Copper networks also require active electricity to operate—they need powered infrastructure at regular intervals. Fiber is passive; light travels through glass without needing external power sources.

From an economic standpoint, maintaining two parallel networks is prohibitively expensive. Openreach has to keep both copper and fiber infrastructure running simultaneously, duplicating costs. Personnel training, spare parts, maintenance scheduling, repair centers—all of it has to exist twice. The scale economics of supporting millions of copper lines that are gradually being abandoned don't work anymore.

Manufacturing is another issue. Copper network equipment is becoming harder to source as suppliers globally shift to fiber-based systems. Companies that made specialized copper switches and interfaces are consolidating or exiting the market. When equipment fails, replacement parts take longer to source and cost more. This creates an accelerating cost spiral that makes the economics of copper maintenance increasingly untenable.

From a capability perspective, copper networks are fundamentally limited. They're voice-only. Modern businesses need data, video conferencing, cloud connectivity, and bandwidth. Copper can't deliver these. Fiber can scale from 1 megabit per second to 10 gigabits per second. It's not just about replacement—it's about moving to technology that can actually support contemporary business needs.

The UK government's role in this is about modernization and digital infrastructure. Countries with outdated telecommunications backbone are at a disadvantage. Modern cloud infrastructure, AI services, high-definition video, and real-time communications all require robust fiber networks. Keeping copper online is essentially maintaining legacy infrastructure that competes with modern systems.

So the shutdown timeline isn't arbitrary. January 2027 was chosen because it provides businesses roughly three years of notice from the time the announcement was made. It's aggressive, but not unreasonable. It's enough time for almost any business to plan and execute migration, provided they actually start the process.

DID YOU KNOW: The UK's PSTN network includes approximately **3.8 million access lines**, but only around **500,000 remain on business circuits**. Residential copper connections have already shifted overwhelmingly to fiber, showing that mass migration is entirely achievable when there's proper incentive and support.

Why the Copper Network Shutdown Was Always Coming - visual representation
Why the Copper Network Shutdown Was Always Coming - visual representation

Vendor Migration Capability Comparison
Vendor Migration Capability Comparison

Colt leads in infrastructure and support, making it ideal for mission-critical needs, while Vodafone offers competitive pricing. Estimated data based on typical market insights.

The Technical Barriers That Have Now Been Eliminated

For years, businesses had legitimate technical reasons for not migrating. These were real problems with real solutions, but they required time and investment to solve. Openreach and the industry collectively spent years removing these barriers.

Telecare and Medical Alert Systems were the biggest challenge. Elderly and vulnerable people rely on devices that communicate through telephone lines to alert emergency services if they fall or experience medical emergencies. These devices use specific frequencies and protocols that work on copper networks. Moving them required either deploying new devices or ensuring compatibility with fiber infrastructure. Openreach developed the "Prove Telecare" service specifically to handle this. Now, medical alert systems have been tested and validated on fiber networks. Alternative technologies like cellular-based systems and internet-connected devices have been developed. This barrier is resolved.

Fax machines were another concern. Some businesses still use fax for legal documents, prescriptions, or compliance reasons. Fax works differently than voice—it's essentially a modem communication protocol. Fiber networks and Vo IP systems can handle fax through various methods: fax-to-email systems, SIP trunks with fax protocols, or dedicated fax servers. The technology exists. It's proven. It works.

Alarm Systems and Security Devices that report via phone lines have been addressed. Modern alarm systems connect through broadband rather than phone lines, or they use cellular backup. The industry has shifted away from copper-dependent alarms. New systems are deployed expecting fiber or cellular connectivity.

Legacy PBX Equipment is another concern, but there are workarounds. Older PBX systems can connect to fiber networks through appropriate gateways and interfaces. Yes, you might need to upgrade some equipment, but businesses can migrate PBX systems without replacing them entirely. Managed service providers have developed solutions for bridging old systems to new networks.

Power Requirements were historically a concern—copper networks had limited backup power in some cases. Fiber networks also need backup power for network equipment, but the infrastructure for this has improved dramatically. Businesses now have options: backup batteries, generators, cellular fallback systems.

The important thing James Lilley from Openreach emphasized was that "all technical barriers have now been eliminated." This is significant because it removes the last legitimate reason for delay. If you're not migrating, it's no longer because the technology doesn't support your use case. It's because you haven't planned the project, haven't allocated budget, or haven't prioritized it. The excuse is gone.

This is why the price hikes are so aggressive—Openreach is essentially saying, "We've solved the hard technical problems. You've run out of reasons to wait. Now we're making the financial argument." It's a two-pronged strategy: remove technical barriers, then create financial pressure. Businesses can no longer claim they "can't" migrate; they can only claim they "haven't" migrated.

The Technical Barriers That Have Now Been Eliminated - visual representation
The Technical Barriers That Have Now Been Eliminated - visual representation

Understanding the Provider Responsibility and What Happens When They Don't Act

Here's where it gets interesting from an accountability perspective. Openreach doesn't deal directly with most businesses. Openreach is the infrastructure operator. Businesses connect through service providers: BT, Vodafone, Talk Talk, Colt, and dozens of others. These providers purchase capacity from Openreach and sell services to end customers.

The responsibility for notifying customers and managing migration falls on these service providers, not directly on Openreach. When Openreach announced the shutdown and price increases, they essentially told service providers, "You need to contact your customers and help them migrate. And you need to do it urgently."

Most major providers have already done this. They've been contacting customers, offering migration packages, and actively moving people off copper. But here's the problem: not all providers are equally diligent. Some are handling thousands of migrations efficiently. Others are slower. A few are apparently dragging their feet.

Openreach's guidance is blunt: if your provider hasn't contacted you, you should question why. Either your provider is incompetent at managing customer communications, or they're hoping you'll simply accept the price increases and stay on copper. Neither is acceptable. The implication is clear: if your provider hasn't contacted you about migration, change providers.

This is actually a useful filtering mechanism. It identifies which providers are taking their responsibilities seriously and which aren't. A provider that contacts customers proactively, offers reasonable migration terms, and helps businesses make the transition is demonstrating competence and customer focus. A provider that goes silent while price hikes loom is demonstrating the opposite.

For businesses, this is an opportunity. If your current provider hasn't contacted you about migration, it might be time to evaluate alternative providers anyway. You could potentially negotiate better terms with a new provider that's actively managing migrations. You gain leverage when you're willing to switch.

The provider space is competitive enough that businesses usually have options. Even in areas with limited fiber competition, providers like Colt, BT Enterprise, and Vodafone Business have coverage and dedicated teams for managing business migrations. Shopping around might reveal better options than you currently have.

QUICK TIP: Contact your service provider today and ask specifically: "What is your plan for my migration off copper? What timeline are you proposing? What costs are involved?" The answer will tell you whether you're with a provider taking this seriously or one you might want to leave.

Understanding the Provider Responsibility and What Happens When They Don't Act - visual representation
Understanding the Provider Responsibility and What Happens When They Don't Act - visual representation

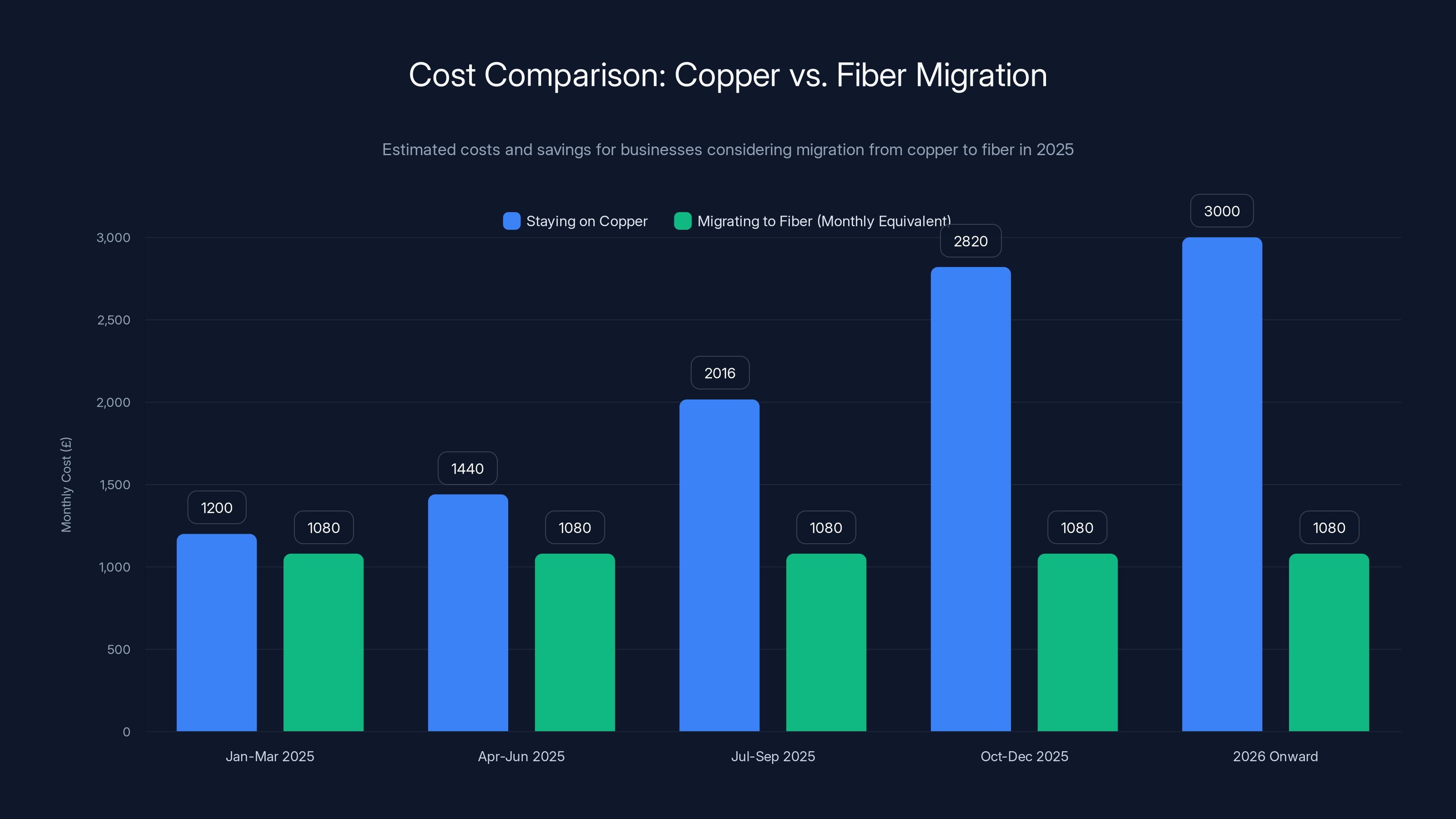

Cost Comparison: Copper vs. Fiber Migration
Cost Comparison: Copper vs. Fiber Migration

Staying on copper sees escalating costs, peaking at £2,820/month by late 2025. Migrating to fiber, despite upfront costs, offers consistent monthly savings, making it financially compelling over time.

The Migration Timeline: 18 Months to Complete a Major Infrastructure Transition

The January 31, 2027 deadline is firm. Openreach isn't negotiating this. After that date, the copper network will be shut down. Copper lines will simply stop working. There's no extension, no "we'll keep it running for a few more years if you ask nicely." It's a hard stop.

Given that we're currently in early 2025, businesses have roughly 18 months to complete a major telecommunications infrastructure transition. For some businesses, that's plenty of time. For others, it's terrifyingly tight.

The migration process typically involves these stages:

Planning and Assessment (Month 1-2): Audit your current infrastructure. What's connected to copper? Which business functions depend on phone lines? What's the current capacity and quality? Do you have backup systems? What are your peak usage periods? This sounds simple but requires coordination between IT, operations, and business continuity teams.

Vendor Selection and Proposal (Month 2-3): Request proposals from fiber providers. Get pricing for your specific requirements. Ask about migration support, redundancy options, and fallback systems. Compare SLA commitments. This is where you determine cost, not just for the new fiber service but for any equipment, consulting, or installation required.

Design and Planning (Month 3-4): Work with your provider to design the new system. Where will fiber connect? How will routing work? Do you need multiple circuits for redundancy? What about backup power? How will you test before cutting over? Design must account for zero-downtime cutover if possible, or minimal downtime if not.

Equipment Procurement (Month 2-5): Order any equipment you need. Routers, switches, phones, gateways—these have lead times. In some cases, popular equipment can take 6-8 weeks to arrive. Starting this early prevents the situation where you're ready to migrate but waiting for equipment.

Stakeholder Communication (Ongoing): Tell your employees, customers, and partners about the change. If you have outbound phone numbers that might change, warn customers early. If your call center depends on specific phone handling, explain what's changing. Internal communication prevents surprises.

Testing (Month 5-6): In a lab or test environment, validate that the new system works. Test failover scenarios. Test that all your integrations (CRM, phone systems, recordings) work with the new connection. Test at scale with realistic traffic patterns.

Pilot Migration (Month 6-7): Move a small group of users to the new system. Maybe a specific department or office. Monitor this carefully. Fix issues while they're small and localized. Get user feedback. This is your dress rehearsal.

Full Migration (Month 7-12): After the pilot succeeds, migrate the entire organization. This might happen in waves if you have multiple locations. The timeline here depends on your size and complexity.

Decommissioning (Month 12-18): Once everyone is on the new system and you've confirmed everything works, formally decommission the copper lines. Notify Openreach. Remove old equipment. Close old contracts. Archive documentation for compliance.

That's 18 months for a textbook migration. Businesses starting now could finish by September 2026, giving themselves a 4-month buffer before the shutdown. Businesses starting in summer 2025 (when the July price hike hits) could still finish by December 2026, though it would be rushed. Businesses waiting until Q4 2025 will be executing under extreme pressure.

The Migration Timeline: 18 Months to Complete a Major Infrastructure Transition - visual representation
The Migration Timeline: 18 Months to Complete a Major Infrastructure Transition - visual representation

Cost Analysis: Migration Expenses vs. Staying on Copper

Let's do the math. This is the analysis that determines whether businesses migrate or delay.

Staying on Copper Scenario:

  • January-March 2025: £100/month per line (12 lines = £1,200/month)
  • April-June 2025: £120/month per line (£1,440/month) +£240
  • July-September 2025: £168/month per line (£2,016/month) +£576
  • October-December 2025: £235/month per line (£2,820/month) +£804
  • January 2026 onward: Copper is "switched off" or costs accelerate further

Total additional cost in 2025 alone: £240 + £576 + £804 = £1,620 extra across all 12 lines. That's just the overage. By early 2026, if the network isn't shut down, it could be even more expensive.

Migrating to Fiber Scenario:

  • Equipment and installation: £3,000-8,000 (one-time, varies by location and complexity)
  • Professional services and consulting: £2,000-5,000 (if you get help with design/cutover)
  • New monthly service: £90-120/month per line (often slightly cheaper or equivalent to inflated copper prices)
  • Training and change management: £1,000-2,000 (internal time and resources)
  • Total upfront cost: £6,000-15,000
  • Monthly savings vs. inflated copper: £15-45/month per line (£180-540/month across 12 lines)

The payback period: £8,000 upfront cost ÷ £350/month savings = roughly 23 months. But this assumes you're comparing against October 2025 copper prices. If you're comparing against current prices and planning a slow migration over 2026, it might take longer. But here's the key: once you're on fiber, you're no longer subject to Openreach's price increases. You've locked in your telecom costs.

Moreover, fiber often comes with better service levels. Faster speeds, lower latency, better redundancy options. You're not just paying the same for equivalent service; you're often getting better service for the same cost.

For most businesses, the financial case for migrating is actually compelling, not just acceptable. The upfront costs are significant but manageable. The monthly cost is often better than the post-hike copper cost. And the service quality improvement is real.

The only businesses for which copper might remain cost-effective are those with extremely minimal telecommunications needs: a single line, no redundancy requirements, and almost no migration complexity. These businesses are rare.

DID YOU KNOW: Fiber adoption among business users is currently at **38%** in areas where it's available. This means **62% of businesses** in coverage areas are still holding onto copper or older technology despite fiber being available. The price hikes are designed to shift that adoption rate dramatically upward.

Cost Analysis: Migration Expenses vs. Staying on Copper - visual representation
Cost Analysis: Migration Expenses vs. Staying on Copper - visual representation

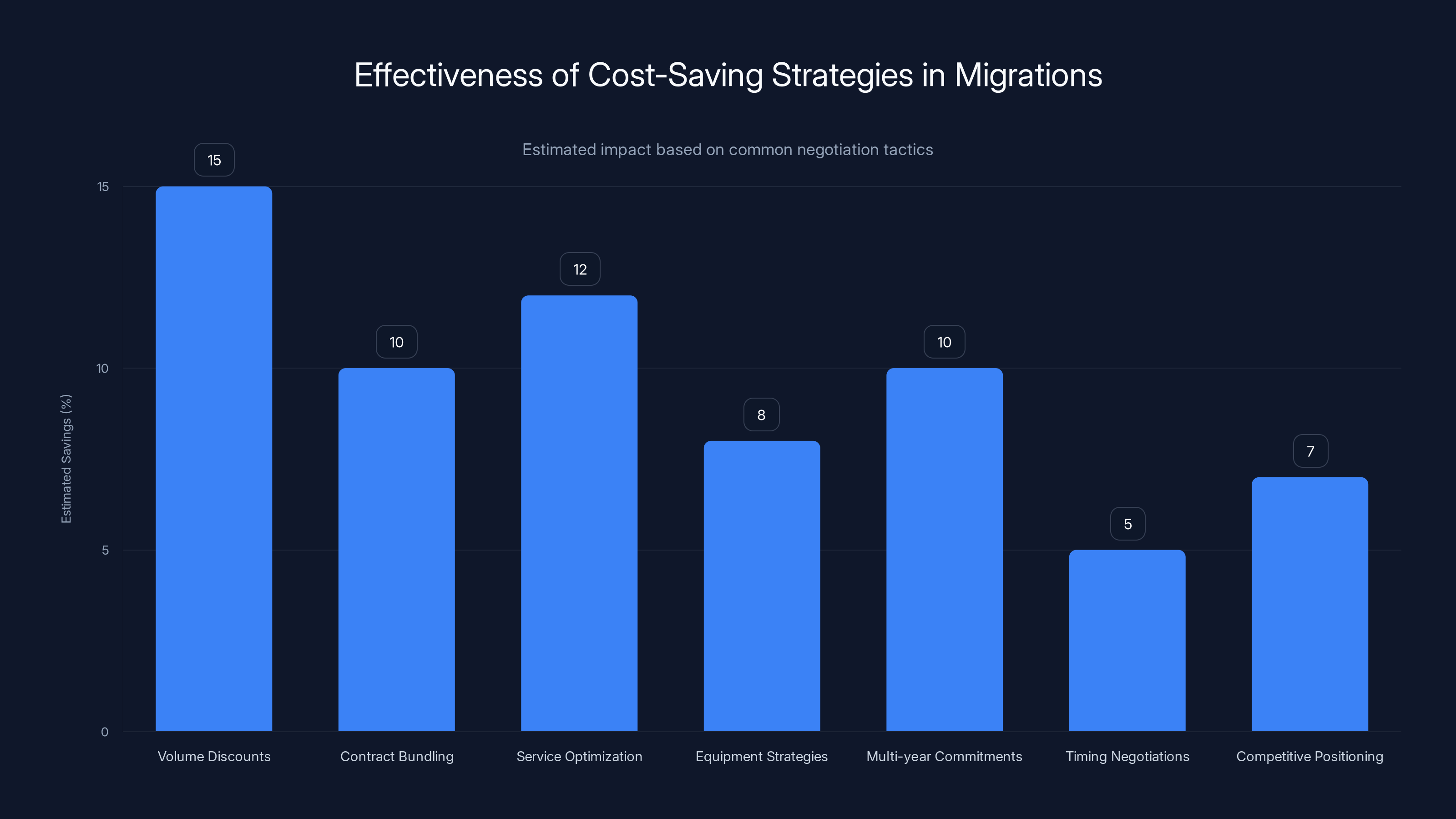

Effectiveness of Cost-Saving Strategies in Migrations
Effectiveness of Cost-Saving Strategies in Migrations

Volume discounts and service optimization are the most effective strategies, potentially saving up to 15% and 12% respectively. Estimated data based on typical negotiation outcomes.

Fiber Optic Connectivity: What Businesses Are Migrating To

When we talk about migration, the destination is usually fiber optic connectivity, either direct fiber to the building (FTTP, Fiber To The Premises) or fiber to the cabinet with copper or wireless last-mile (FTTC or wireless backhaul).

Fiber offers transformative improvements across almost every dimension:

Speed: Copper delivers up to 20-30 Mbps realistically for telephone lines, potentially faster for newer ADSL technology but still limited. Fiber delivers 30 Mbps to 1+ Gbps depending on the package. For businesses that do video conferencing, cloud backups, or any data-intensive operations, this is life-changing.

Latency: Copper networks have higher latency because of the way the technology works. Fiber has lower latency, which matters enormously for real-time applications like voice calls, video, and interactive services. Voice over fiber is clearer and more reliable.

Reliability: Copper is vulnerable to weather, electromagnetic interference, and water damage. Fiber is immune to electromagnetic interference and far more weather-resistant. Fiber networks typically deliver 99.5%+ uptime. Copper networks historically delivered 95-97% uptime.

Scalability: If your business grows and you need more capacity, copper requires physical network upgrades, which are slow and expensive. Fiber can often increase capacity by simply changing your service package. The infrastructure is already there.

Cost Trajectory: Copper gets more expensive as infrastructure ages and vendors exit the market. Fiber gets cheaper as deployment scales and technology improves. Your long-term cost trajectory improves with fiber.

Security: Fiber is fundamentally more secure. It can't be intercepted without physical access and specialized equipment. Copper can be tapped. For businesses with security-sensitive communications, fiber is substantially better.

Future-Proofing: Fiber infrastructure can support technologies we haven't even invented yet. Copper is at the end of its lifecycle. Investing in fiber is investing in infrastructure that will be relevant for 20+ years. Copper will be obsolete by 2027.

From a business continuity perspective, fiber is simply superior across every meaningful dimension. The migration isn't just compliance with a shutdown deadline—it's upgrading to fundamentally better infrastructure.

The types of fiber services available include FTTP (most common, most expensive), FTTC (medium cost, medium performance), and business fiber packages from providers like BT Enterprise, Vodafone Business, and Colt. These packages often include SLA commitments, redundancy options, and managed services.

Businesses should also consider hybrid approaches: fiber as the primary connection with cellular or wireless backup. This eliminates single points of failure and provides business continuity even if one connection fails.

Fiber Optic Connectivity: What Businesses Are Migrating To - visual representation
Fiber Optic Connectivity: What Businesses Are Migrating To - visual representation

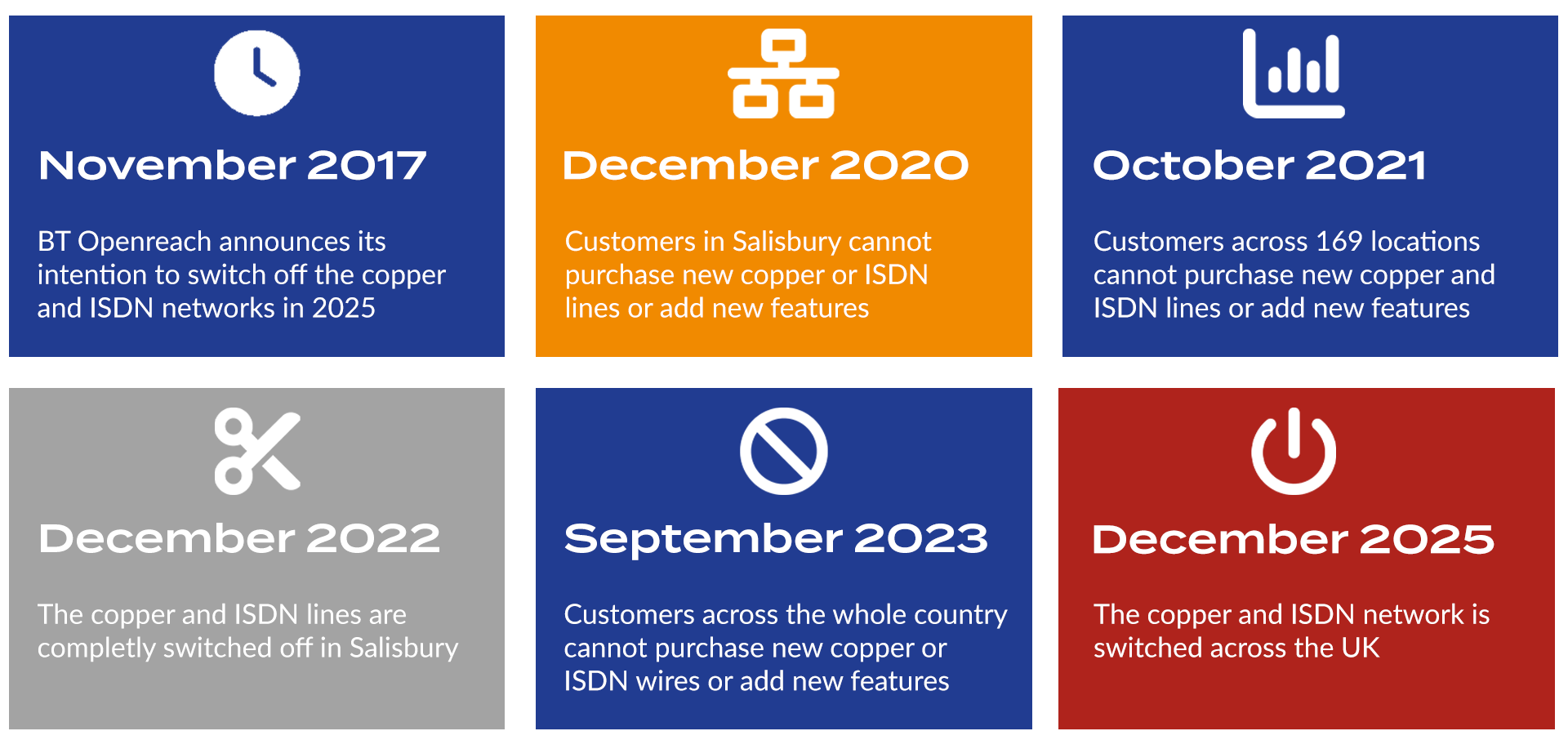

SLA Commitments and Service Level Guarantees

One often-overlooked aspect of migration is SLA commitments. Copper networks were often provided without explicit SLAs. Service was expected to be reliable, but there weren't formal guarantees with remedies if they failed.

Fiber services come with explicit, contractual SLAs. Typically 99.5% uptime (4 hours of downtime per month) for business-grade fiber. Premium services offer 99.9% uptime (43 minutes per month). These commitments include financial penalties if the provider misses the SLA.

This is actually valuable beyond the pure availability number. When you have an SLA, the provider has contractual liability if they fail. They have to track uptime formally. They have to document outages. They have to take corrective action if they're trending toward an SLA breach. You have recourse if they underperform.

When evaluating fiber providers, the SLA is worth negotiating. Don't just accept the standard offering. Ask about higher-tier SLAs, what's covered, what's excluded, and what the remedies are. For businesses where communications are critical to operations, a 99.9% SLA with penalties might be worth paying extra for.

Also consider redundancy at the SLA level. If you have two independent fiber connections from different providers, even if one fails, you have backup. This improves your actual availability to 99.99% or better, but requires paying for dual service. For critical operations, this is worth considering.

SLA Commitments and Service Level Guarantees - visual representation
SLA Commitments and Service Level Guarantees - visual representation

Projected Cost Increase of Copper Network Lines
Projected Cost Increase of Copper Network Lines

Openreach plans to double copper network costs by October 2025 through a series of price hikes, starting with a 20% increase in April and reaching 140% by October. Estimated data.

The Employee and Customer Impact of Service Transitions

While the financial and technical aspects of migration are important, the human impact shouldn't be underestimated.

Employees notice telecommunications changes. Their phone system changes. They might need new phones or new software. If call routing changes, the way they transfer calls changes. If phone numbers change, external contacts need new information. Customers might call old numbers. Suppliers might not be able to reach you during transition.

Planning should include user training and change management. When the new system goes live, your team needs to understand how to use it. There should be clear documentation, a help desk ready to support issues, and patience built in while people adapt.

Customers also notice. If your main phone number changes, you might lose calls from existing customers who call old numbers. Signage, voicemail, email signatures, and marketing materials all need updating. Website contact pages need to reflect new numbers. This seems obvious but gets overlooked in the technical focus of migrations.

Businesses should plan for temporary volume increases in the help desk and support functions. When new systems go live, you get more support requests, not fewer. Staffing appropriately during cutover week is essential.

Communications planning should start months before migration. Tell employees "in Q3, we're upgrading our phone system. Here's what's changing. Here's what won't change. Here's how to use the new system. Here's where to get help." Repeat this message multiple times. Test it with a pilot group. Iterate based on feedback. Then roll out to everyone with confidence.

Customers should be notified of number changes in advance. "Starting April 1st, our main number is changing from [old] to [new]. Both numbers will work through June 30th, then the old number will stop working. Please update your records." Give people time to adjust.

The Employee and Customer Impact of Service Transitions - visual representation
The Employee and Customer Impact of Service Transitions - visual representation

Compliance and Documentation Requirements

During migration, certain compliance and documentation requirements apply, depending on your industry.

Telecom documentation: If you have regulated telecommunications services (call centers subject to regulations, utilities, healthcare), there may be specific notification requirements before changing your phone infrastructure. Check with your regulatory body.

Call recording and retention: If your business records calls (for compliance, training, or QA), ensure the new system preserves these capabilities. Some fiber Vo IP systems handle recording differently than legacy copper systems. This needs to be tested and validated.

Disaster recovery: Document how the new system integrates with your disaster recovery plan. What happens if fiber is cut? What's your backup? How quickly can you failover? This should be tested.

Security and data handling: If calls carry sensitive information, understand how the new fiber system protects this. Are calls encrypted? How are recordings stored? Who has access? This matters for HIPAA, PCI, and other compliance frameworks, as noted by HIPAA Journal.

Emergency services (999/112): Test emergency calling from the new system. Location data for emergency responders needs to be accurate. This has been a historically tricky aspect of Vo IP migrations. Validate that your new system correctly reports your business location to emergency services.

Accessibility: If your organization needs to support accessibility requirements (relay services, TTY compatibility), ensure the new system supports this.

These might seem like edge cases, but they matter enormously if you're in a regulated industry. Budget time for compliance validation as part of migration planning.

Compliance and Documentation Requirements - visual representation
Compliance and Documentation Requirements - visual representation

What About Businesses Resistant to Migration

Some businesses will resist migration despite the economic and technical arguments. Understanding why helps explain the market dynamics.

Inertia: This is the biggest factor. Copper systems work. They're familiar. People know how to use them. Switching requires change, and change creates friction. This is purely psychological but real. For many business leaders, staying with what works is the path of least resistance, even if economically irrational.

Risk aversion: Some business leaders genuinely worry about disruption. "What if the new system fails during our peak business period? What if there are issues we haven't anticipated?" These fears aren't entirely unfounded—major transitions do sometimes have hiccups. The solution is thorough planning, testing, and rollback procedures, but risk-averse leaders might not be convinced.

Budget constraints: Migration costs upfront, even though long-term economics improve. Businesses with tight cash flow might struggle to justify the capital expenditure, even if it saves money eventually. This is a real constraint for small businesses.

Legacy system dependencies: Some businesses have custom systems integrated into their copper phone lines in ways that are hard to unwind. These integrations exist but are undocumented. Switching requires reverse-engineering these integrations, which is expensive and risky. This is legitimate, though increasingly rare as older systems retire.

Staffing and expertise gaps: Some businesses don't have IT staff with fiber/Vo IP expertise. They're unfamiliar with the new technology. The thought of managing a new system intimidates them. Outsourced managed service providers can mitigate this, but some businesses don't trust external providers with critical infrastructure.

Skepticism about provider claims: Some businesses have had bad experiences with provider promises in the past. "They said fiber would improve our speeds, and it didn't," or "They said migration would be smooth, and it was a nightmare." This justified skepticism makes people cautious about believing provider assurances.

For these businesses, the price hikes serve their intended purpose: they overcome inertia by making the status quo economically painful. When copper costs double, suddenly the decision becomes, "Can we afford NOT to migrate?" rather than "Can we afford to migrate?" This flips the mental framework and overcomes resistance.

What About Businesses Resistant to Migration - visual representation
What About Businesses Resistant to Migration - visual representation

Regional Variations and Coverage Gaps

While fiber is rolling out nationwide, coverage isn't universal. Some areas have fiber available. Others have partial coverage. A few areas have minimal fiber infrastructure.

Openreach's fiber rollout has prioritized high-density urban areas first. Suburban areas are well-covered. Rural areas have sparser coverage. Businesses in areas without available fiber have a legitimate problem: they can't migrate even if they want to.

For these businesses, Openreach and competitors are exploring alternatives:

Wireless fixed access: Delivering broadband and connectivity through wireless networks (4G/5G) instead of fiber. This is increasingly viable and offers better speed than copper in many cases.

Satellite connectivity: For truly remote areas, satellite internet is an option, though with higher latency and potential weather vulnerabilities.

Extended copper life: In areas where fiber deployment is years away, copper service might be extended past 2027, though likely at even higher costs.

Businesses in low-coverage areas should contact their service providers and Openreach specifically to understand available alternatives. There usually are options, but they might not be obvious.

Coverage checklist: Are you in an area with fiber available? (Check Openreach's checker tool online.) If not, what's your timeline for fiber deployment? What interim solutions are offered? What's the fallback if nothing is available by January 2027? These questions need answers sooner rather than later.

Regional Variations and Coverage Gaps - visual representation
Regional Variations and Coverage Gaps - visual representation

Setting Up Backup and Redundancy During Migration

A critical aspect of migration planning is ensuring zero (or minimal) downtime. This requires backup and redundancy strategies.

During planning: Identify your business's peak usage times and maximum downtime tolerance. If you're a call center, you can't afford an hour without phone service. If you're an office with occasional customer calls, 30 minutes of downtime might be acceptable. Define this before design starts.

Dual connectivity: During migration, operate both copper and fiber in parallel until you're confident everything works. This means you're paying for both services for a window of time, but it provides safety. If something goes wrong with the new system, you can fall back to copper instantly.

Staged rollout: Rather than switching everyone at once, move departments or locations in waves. This limits impact if something goes wrong and allows you to catch issues with small groups before they affect everyone.

Testing protocols: Before any production change, test thoroughly in a lab or test environment. Create realistic traffic patterns. Test all integrations. Test failover scenarios. Document everything.

Runback procedures: If something goes wrong on cutover day, what's your procedure to quickly return to the old system? This should be documented, tested, and clearly understood by your migration team.

Support staffing: Have extra support staff available during cutover. Phone issues during cutover are inevitable. Be prepared to handle them quickly.

Redundancy adds cost and complexity, but it's insurance against the worst-case scenario. Evaluate whether your business can tolerate outage. If not, invest in redundancy.

Setting Up Backup and Redundancy During Migration - visual representation
Setting Up Backup and Redundancy During Migration - visual representation

Vendor Comparison: Which Providers Are Handling Migration Well

Not all service providers are equally well-prepared for managing large-scale migrations. Some have invested heavily in infrastructure and support. Others are less prepared.

BT Business: As the largest incumbent, BT has extensive fiber infrastructure and dedicated migration teams. They're handling high volumes of migrations. Their support is generally solid, though sometimes bureaucratic.

Vodafone Business: Strong fiber footprint with competitive pricing. Good migration support and SLA commitments. Growing share of business customers migrating away from competitors.

Colt: Premium provider with excellent infrastructure and support. More expensive but often worth it for mission-critical connectivity. Particularly strong in urban areas and with larger businesses.

Talk Talk Business: Moderate capabilities. More budget-friendly but with less premium support. Good for price-conscious small businesses.

Hyperoptic: Newer fiber provider with strong presence in urban areas. Premium service levels. Good for businesses willing to switch providers for superior infrastructure.

Independent providers: Smaller regional providers sometimes have strong local support and competitive pricing. Worth evaluating if you're in their coverage area.

When evaluating providers, consider:

  • Fiber coverage in your area
  • Pricing for your required bandwidth
  • SLA commitments and remedies
  • Migration support and expertise
  • Long-term infrastructure investment
  • Customer reviews and satisfaction ratings
  • Flexibility on contract terms

This is also an opportunity to renegotiate your telecom costs. Use the migration as leverage. Get competitive quotes. Current providers often have the advantage of knowing your existing setup but might also be comfortable with higher margins. New providers are hungry for business. This asymmetry can work in your favor.

QUICK TIP: Request proposals from at least 3 providers before committing. Include not just pricing but migration support, SLAs, and long-term commitment terms. You'll often find 20-30% cost variations and significantly different support levels.

Vendor Comparison: Which Providers Are Handling Migration Well - visual representation
Vendor Comparison: Which Providers Are Handling Migration Well - visual representation

Long-term Infrastructure Planning Beyond 2027

While the immediate deadline is January 2027, thinking beyond this is important for sustainable infrastructure decisions.

Fiber evolution: Fiber isn't static. Speeds and capabilities continue improving. Technology that seems cutting-edge in 2025 might be standard in 2030. When you migrate to fiber now, you're not just solving the copper problem—you're positioning yourself for future growth without another major infrastructure change.

Cloud and hybrid models: As more of your infrastructure moves to cloud services, connectivity quality matters more. Direct fiber to cloud provider hubs is increasingly valuable. Planning migrations with this trajectory in mind ensures you don't have to change twice.

Redundancy maturity: Many businesses will move to fiber with a single connection. Over time, as they understand fiber benefits, they might add redundancy or failover paths. Plan your migration architecture to allow this evolution.

Security hardening: Modern connectivity should include DDo S protection, WAN optimization, and security features. These might not be necessary day one but will become more relevant as your business depends more heavily on connectivity.

Remote work accommodations: The post-pandemic world includes distributed teams. Better home connectivity for staff, VPN performance, video conferencing quality—all of this depends on solid primary connectivity. Fiber enables this infrastructure.

The migration to fiber shouldn't be viewed as a one-time compliance project. It should be viewed as a strategic infrastructure modernization that positions your business for better operations, security, and resilience going forward.

Long-term Infrastructure Planning Beyond 2027 - visual representation
Long-term Infrastructure Planning Beyond 2027 - visual representation

Cost-Saving Strategies and Negotiation Tactics

Migrations present opportunities to reduce costs if you approach them strategically.

Volume discounts: If you're migrating multiple locations, you have leverage. Providers often offer volume discounts. Structure the deal to include all locations and negotiate discounts based on total commitment.

Contract bundling: Combine voice, data, and connectivity into a single contract with a single provider. This often results in better pricing than buying services separately from different vendors.

Service package optimization: Map your actual usage and requirements. You might think you need more bandwidth than you actually do. Conservative planning often leads to overspecification. A detailed audit might reveal opportunities to right-size the service and save money.

Equipment strategies: Determine whether you'll use provider-supplied equipment or bring-your-own. Provider equipment is typically included in service costs but may have lower flexibility. Own equipment requires capital investment but often performs better. Analyze the economics in your specific situation.

Multi-year commitments: Providers offer discounts for longer contract terms (2-year vs. 1-year, 3-year vs. 2-year). If you're confident in the provider, longer terms often come with lower monthly rates.

Timing negotiations: Prices and offers can vary seasonally. Enterprise providers often have quarterly or annual promotions. Timing your migration to coincide with these (if possible) can yield savings.

Competitive positioning: Use competing quotes to negotiate. "Provider A is quoting £X for comparable service. Can you match or beat it?" Provider relationships are rarely purely transactional. Many providers will invest in keeping existing customers by matching competitive offers.

Internal capability assessment: Be honest about what you can manage yourself vs. what requires professional services. Some businesses can execute migrations with internal IT staff. Others should outsource to specialists. Get realistic quotes for both approaches.

These tactics might seem nickel-and-dime, but in the context of business connectivity, they can result in thousands of pounds in annual savings. Migration planning is the right time to be strategic about costs.

Cost-Saving Strategies and Negotiation Tactics - visual representation
Cost-Saving Strategies and Negotiation Tactics - visual representation

FAQ

What exactly is the PSTN and why is the UK shutting it down?

The Public Switched Telephone Network is the traditional copper-based telephone infrastructure that's been the backbone of UK communications for nearly a century. It's being shut down because it's aging, expensive to maintain, and inferior to fiber technology that can deliver superior speed, reliability, and capability. Countries globally are making this transition. The UK's deadline is January 31, 2027.

How much will migration to fiber cost my business?

Migration costs vary widely depending on your location, current infrastructure, and requirements. Typically, expect £3,000-15,000 in upfront costs for equipment, installation, and professional services, plus monthly service charges that often match or undercut inflated copper prices. For a rough estimate, total first-year cost (upfront plus 12 months of service) is typically 10-30% higher than current copper costs, but then costs stabilize while copper costs keep rising. This usually pays back within 12-24 months through operational improvements and avoided price increases.

Can I stay on copper after January 31, 2027?

No. The copper network will be shut down. After that date, copper service simply won't exist. Openreach isn't extending the deadline. The only way to maintain telephone service is to migrate to fiber or an alternative like wireless fixed access. Delaying migration doesn't preserve options—it just compresses the timeline and increases pressure.

What about my old phone system and equipment?

Most older phone systems can be adapted to work with fiber networks through gateways and translation equipment. You don't necessarily need to replace everything. However, very old systems (pre-1990s) might not be compatible. Professional assessment during planning will identify what can be retained vs. what needs replacement. Many businesses use migration as an opportunity to upgrade to modern Vo IP systems, which offer better features than legacy equipment anyway.

Will my phone number change during migration?

Phone numbers don't have to change, but they might depending on your provider and location. Number porting is possible—your existing number can typically be moved to the new provider. However, some geographic constraints apply. Discuss this specifically with your provider during the proposal phase. If porting is necessary, most providers can facilitate it, though there might be brief periods where the old and new systems coexist.

What happens to businesses in areas without available fiber?

Fiber rollout isn't complete everywhere, particularly in rural areas. For businesses in coverage gaps, providers are offering alternatives: wireless fixed access (4G/5G connectivity), satellite internet, or in some cases, extended copper service at premium pricing. Contact your provider and Openreach directly to understand options in your specific location. Don't assume you're stuck—most areas have at least interim solutions.

How long does a business phone migration typically take?

From initial planning to complete migration, expect 5-9 months for a standard business. Smaller businesses might do it in 3-4 months. Larger, complex organizations might take 12+ months. The price hikes provide incentive, but they don't eliminate the time required for proper planning, testing, and execution. Starting now allows for deliberate, well-executed migrations. Starting later in 2025 forces rushed decisions under pressure.

What's the best strategy for avoiding downtime during migration?

Run both copper and fiber in parallel until you're confident everything on the new system works reliably. This means paying for both services temporarily but provides safety. Migrate departments or locations in waves rather than everything at once. Test extensively beforehand. Have runback procedures documented. Stock your support team during cutover. Plan migration during low-traffic periods if possible. Zero downtime is achievable but requires investment in planning and potentially in temporary dual service costs.

Are service level agreements (SLAs) important for my business?

Yes. SLAs provide contractual guarantees about uptime and include financial remedies if providers miss their commitments. Standard business fiber offers 99.5% uptime (4 hours per month). Premium services offer 99.9% (43 minutes per month). Evaluate your actual business need—some businesses truly can't afford an hour of downtime; others can. Matching SLA to actual need prevents overpaying for unnecessary guarantees.

What should I do if my current provider hasn't contacted me about migration?

Contact them directly and ask about their migration plan for you. If they're vague or unhelpful, this is a red flag about their competence or customer focus. You might consider switching providers to one that's actively managing migrations. A provider proactively managing customer transitions is demonstrating competence. One going silent while prices rise is not.

How do I start the migration process?

Begin with an audit: inventory everything connected to copper. Request proposals from multiple providers. Ask specifically about migration support, timelines, and costs. Work with your chosen provider to design the new system. Plan thoroughly. Test extensively. Execute in phases. Don't wait for price hikes to force action—migrations planned under pressure tend to be more expensive and riskier than migrations planned deliberately.

FAQ - visual representation
FAQ - visual representation

The Bottom Line: Why Now Is the Time to Act

The Openreach price hikes aren't a surprise or a negotiable policy. They're a calculated strategy to accelerate migration before the 2027 shutdown deadline. The pricing is aggressive by design. It's meant to overcome inertia and force decisions.

But here's the thing: even setting aside the price pressure, fiber migration is the right choice for almost every business. The service quality is better. The reliability is superior. The capacity is infinitely scalable. The future-proofing is real. You're not just complying with a shutdown—you're upgrading to better infrastructure.

The timeline is tight. Eighteen months from now sounds like plenty of time until you start the planning process and realize how many steps are involved. Migrations that take months to plan and execute can't be rushed at the last minute without risk and cost overruns.

The optimal strategy is straightforward:

First, assess where you are today. What's connected to copper? What's your current provider doing about migration? What's available in your area? If you haven't had this conversation with your provider, have it this week.

Second, design your target state. What service do you actually need? What redundancy is appropriate? What are you willing to invest in? What's the timeline that works for your business?

Third, get competitive proposals. Don't assume your current provider is your only option. Other providers often have better offerings or more aggressive migration support.

Fourth, plan thoroughly. Migration isn't something you improvise in October 2026 when copper costs have tripled and your patience is exhausted. Plan in 2025 while you have time to do it right.

Fifth, execute deliberately. Test before you flip switches. Have fallback procedures. Support your teams through the change. Document what you've done.

Businesses that complete migrations in 2025 will have the luxury of operating confidently on fiber, verifying everything works, and potentially avoiding the last-minute rush of 2026. Businesses that delay will be executing under pressure, paying premium prices, and accepting elevated risk.

The copper network is going away. That's certain. The price increases are real. That's certain too. What's uncertain is how you'll handle the transition. Being deliberate and proactive puts you in control. Reacting to deadline pressure puts circumstances in control of you.

The decision is yours. But the clock is running, and it's running faster than you probably think.

The Bottom Line: Why Now Is the Time to Act - visual representation
The Bottom Line: Why Now Is the Time to Act - visual representation

Key Takeaways

  • Openreach is raising copper prices 20% in April, then 40% in July and October 2025, totaling approximately 100% increase by year-end
  • The UK's PSTN copper network shuts down completely on January 31, 2027, with 500,000 business lines still unmigrated
  • All technical barriers to migration have been eliminated: telecare systems work on fiber, fax compatibility is solved, legacy equipment has workarounds
  • Migration typically costs £6,000-15,000 upfront plus service changes, but shows positive ROI within 12-24 months compared to inflated copper pricing
  • Fiber provides superior speed (30-1000+ Mbps vs. 20 Mbps), reliability (99.5%+ vs. 96%), and future-proofing compared to legacy copper networks

Related Articles

Cut Costs with Runable

Cost savings are based on average monthly price per user for each app.

Which apps do you use?

Apps to replace

ChatGPTChatGPT
$20 / month
LovableLovable
$25 / month
Gamma AIGamma AI
$25 / month
HiggsFieldHiggsField
$49 / month
Leonardo AILeonardo AI
$12 / month
TOTAL$131 / month

Runable price = $9 / month

Saves $122 / month

Runable can save upto $1464 per year compared to the non-enterprise price of your apps.
